Three Maids Hill

Case study:
Three Maids Hill, Winchester

Case study location:  Three Maids Hill, Winchester, Hampshire

The client: InstaVolt

Charging stations: 44 Rapid chargers

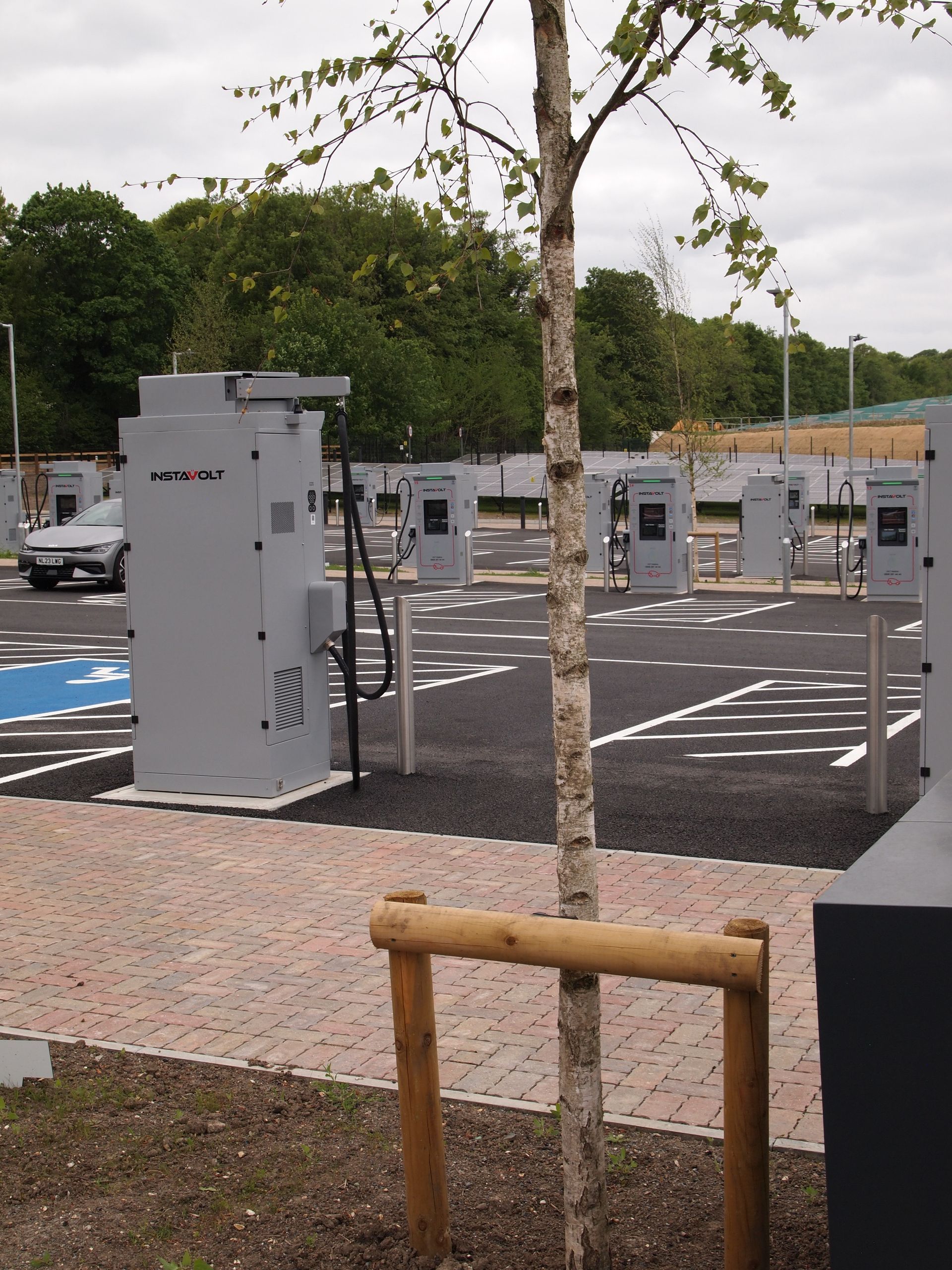

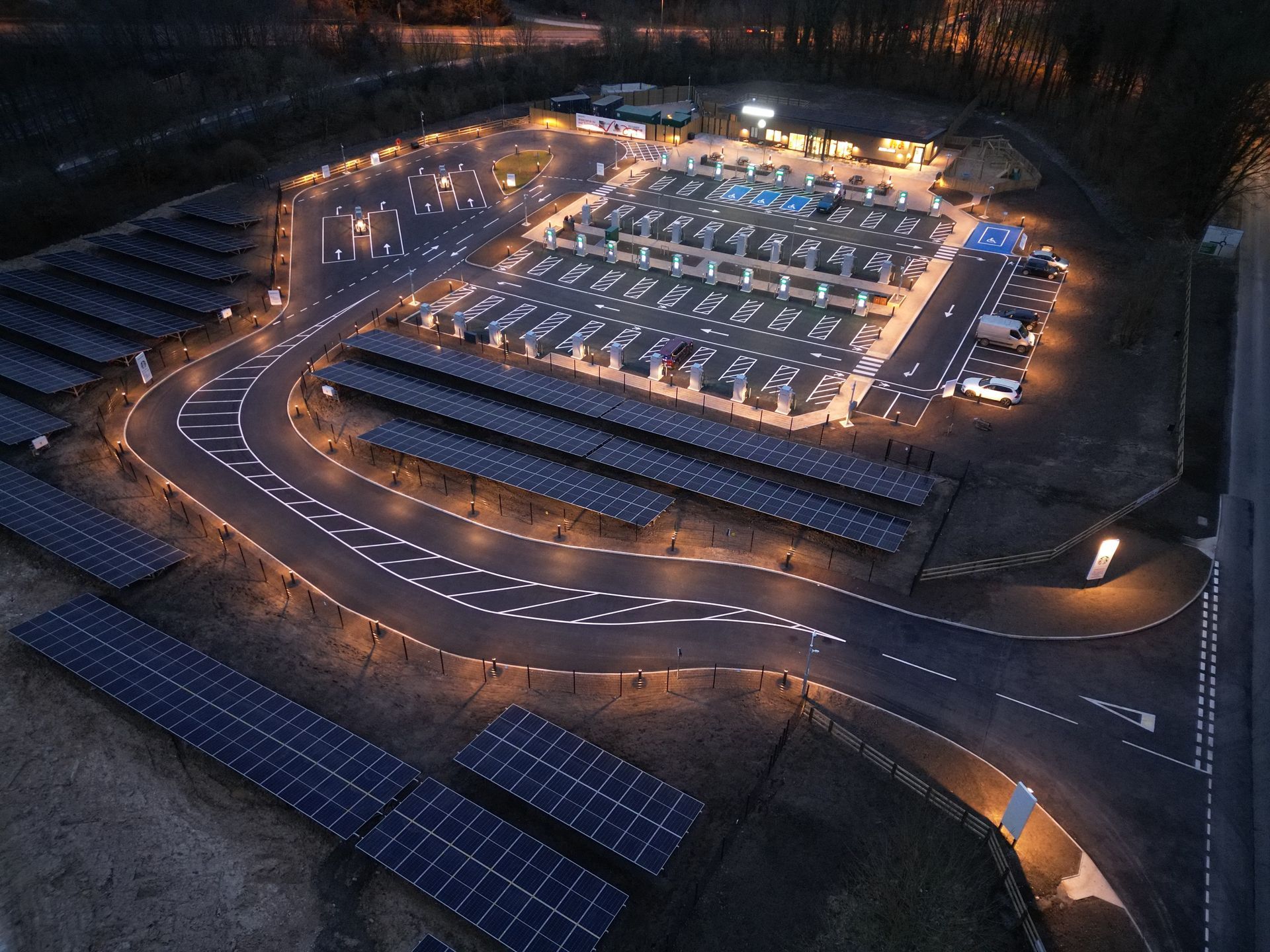

Opening date: Coming Spring 2025

The proposal: Located at Three Maids Hill just metres from the A34 junction close to the M3 in Hampshire, the super hub will have 44 charging bays, including drive-through bays for large/ towing vehicles and accessible charging bays, as well as an on-site restaurant and play area.

PUBLISHED: August 2024
Share this news:

Building the UK’s largest rapid-only EV charging Super Hub

Parco CiviI Engineering & Groundworks are once again proud to have been chosen as the principal contractor working with InstaVolt, the UK's leading EV charging network, to create the UK’s largest rapid-only EV charging super hub.

Key highlights of the contract include:

  • Parco appointed Principal Contractor for works
  • S278 design and submission to local authority
  • On site civils design
  • Ground modelling designs including cut and fill design
  • Install and maintain site compound and site hoarding
  • All groundworks and enabling works
  • Installation of street lighting
  • All on site utility enabling works
  • On-site ducting for solar farm
  • Drainage works
  • Design and install of playground facilities

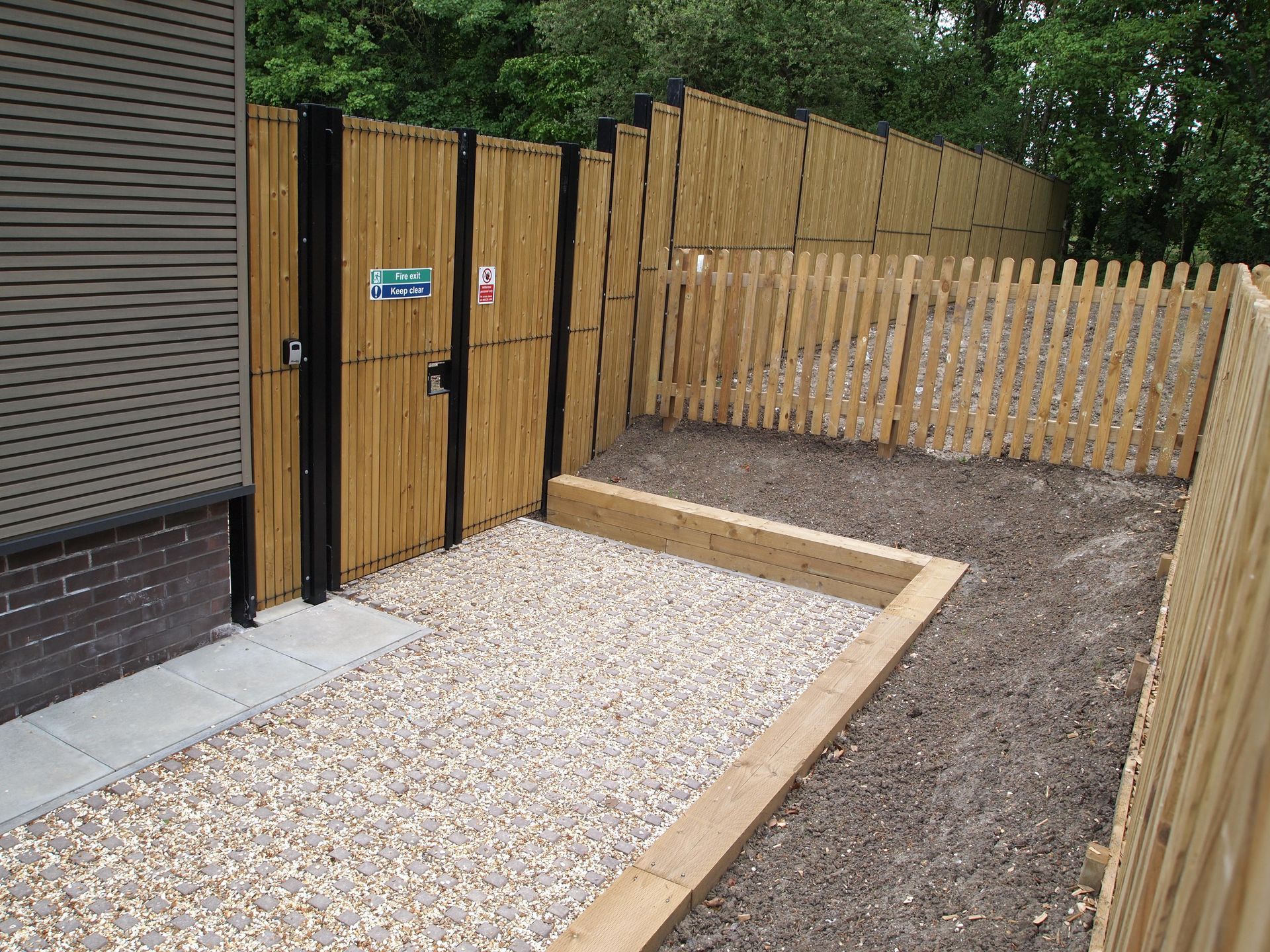

  • Full soft landscaping of the area

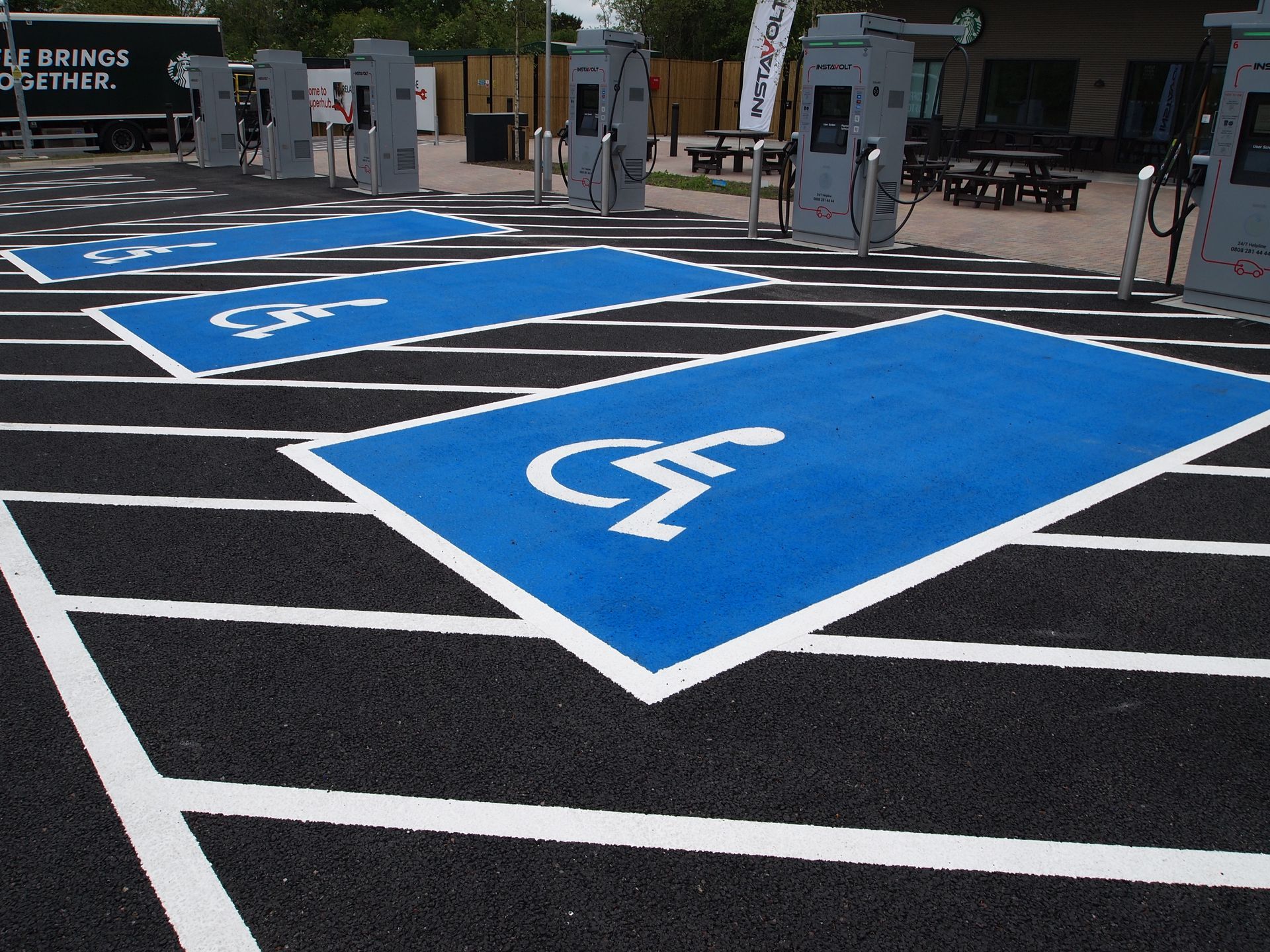

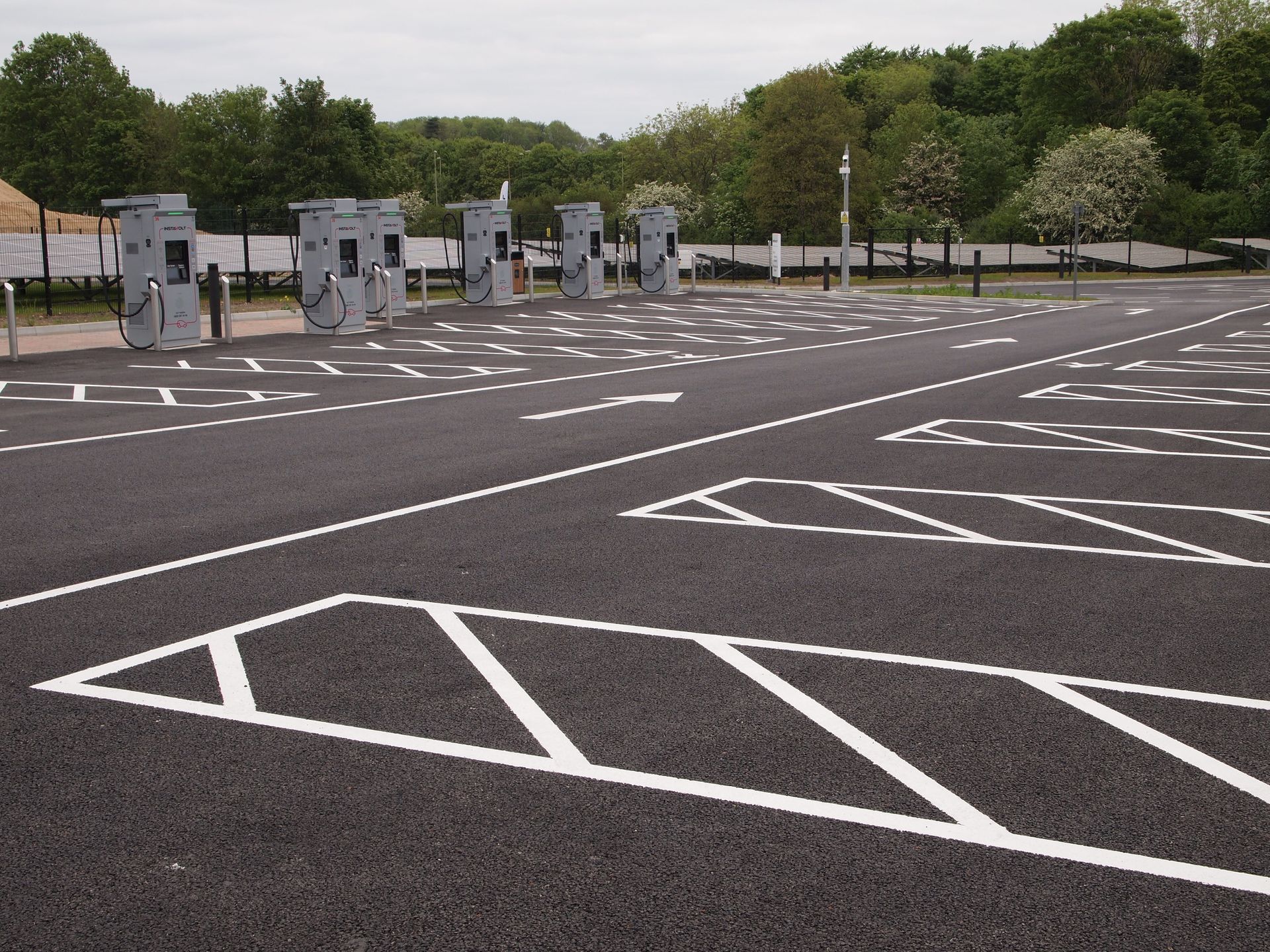

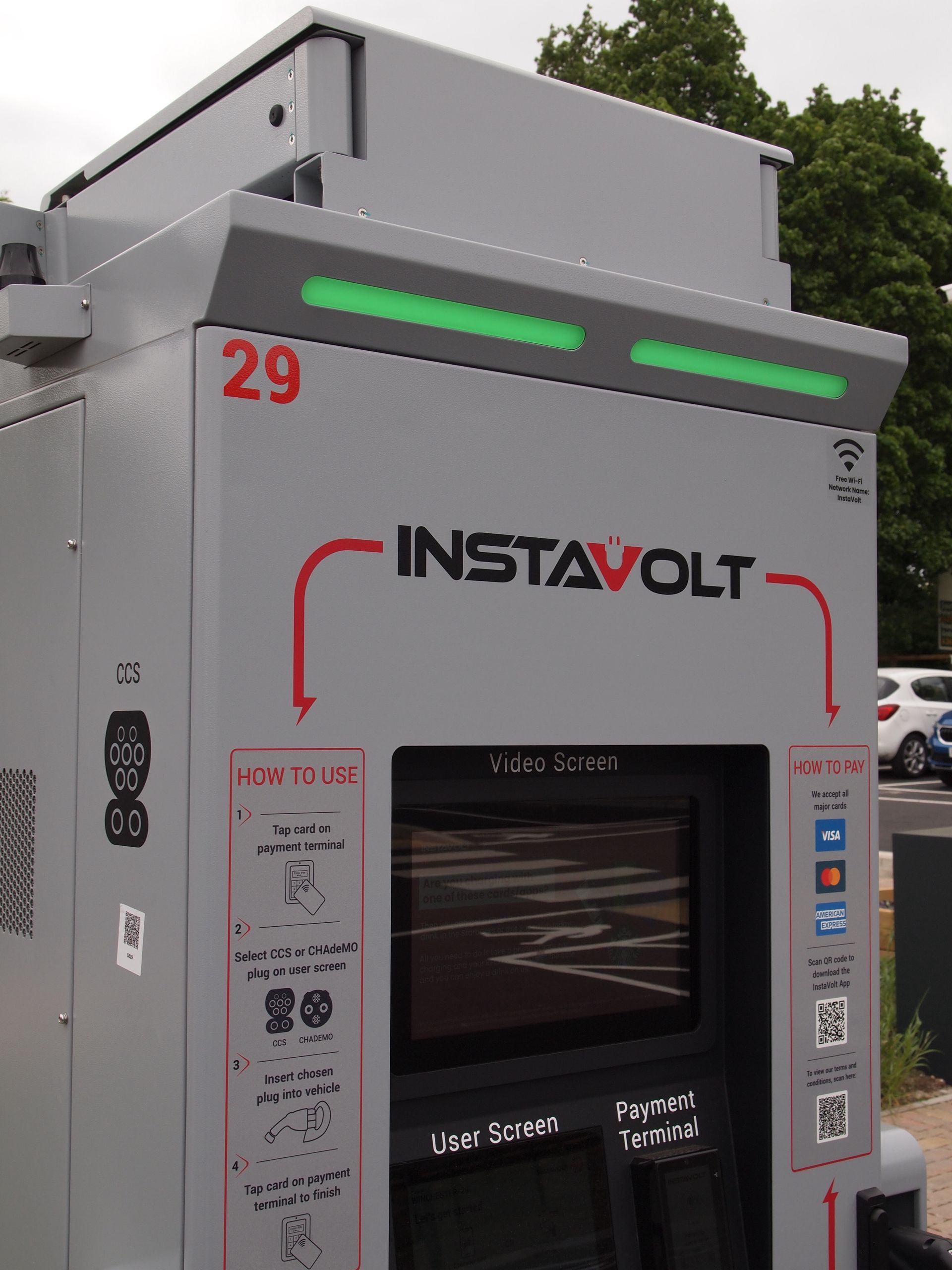

  • Deliver and install 44 rapid chargers

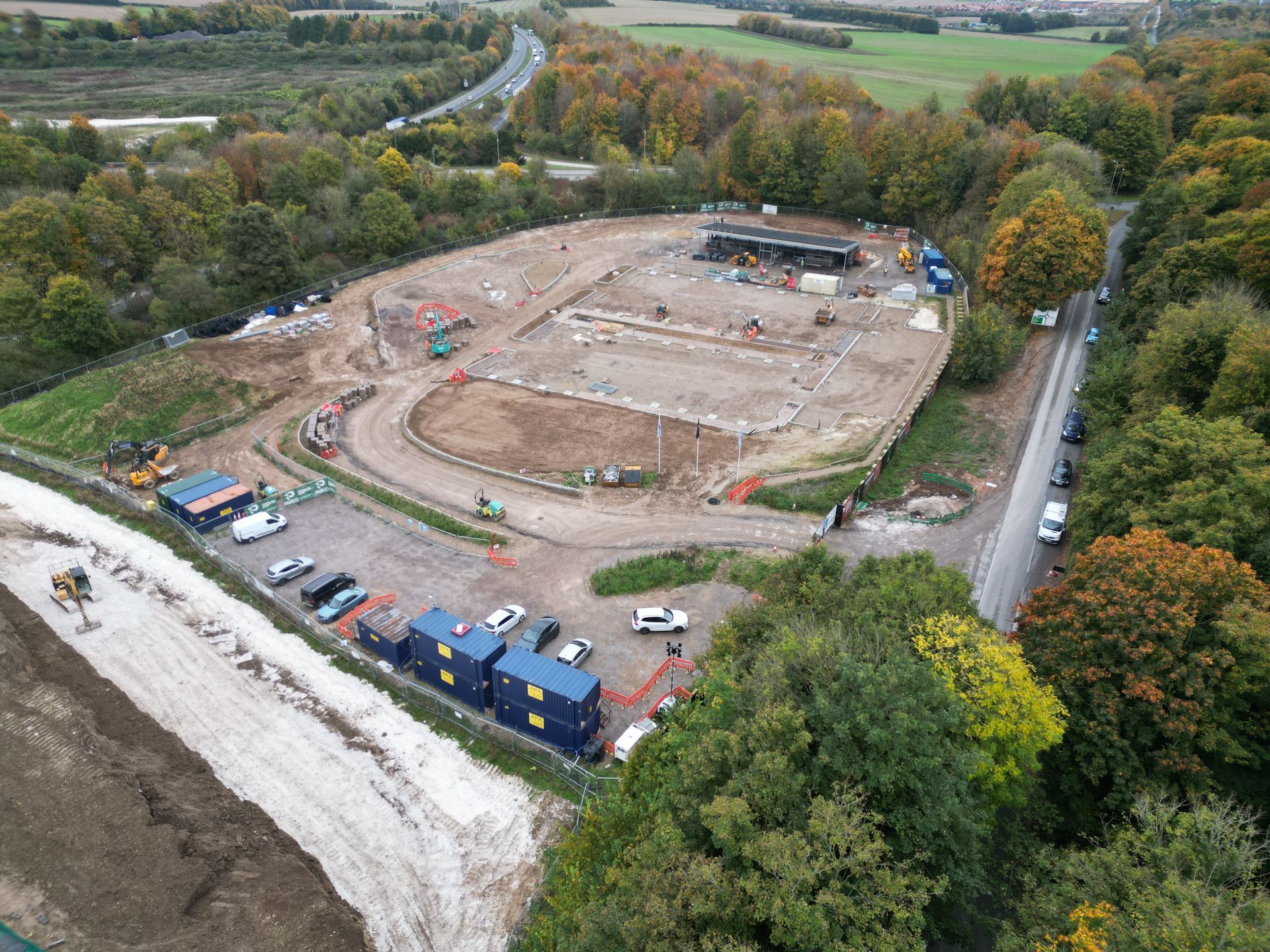

Site development update - October 2024:

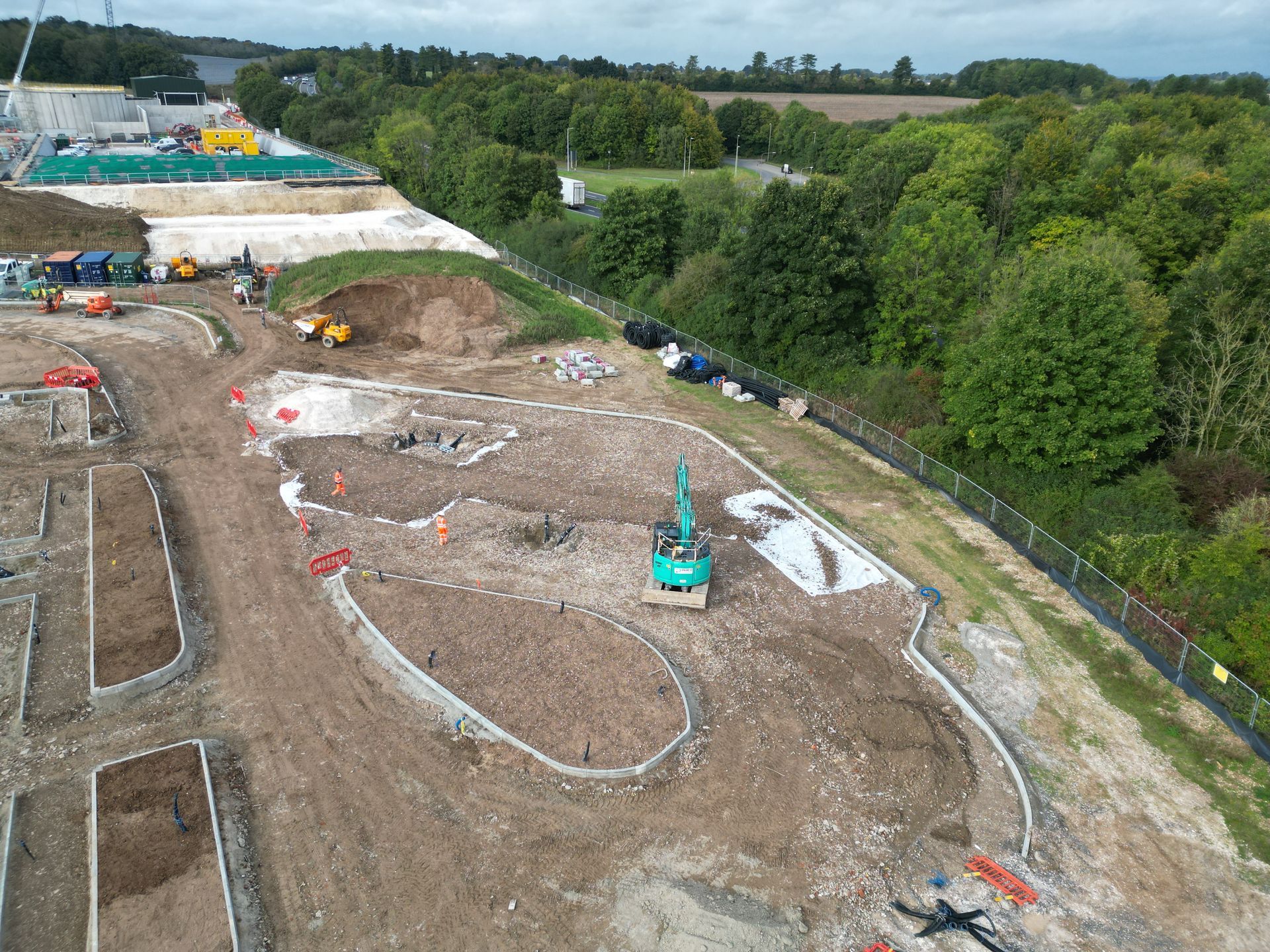

Another productive month for the EV super hub site build at Winchester. Targets hit this October include:

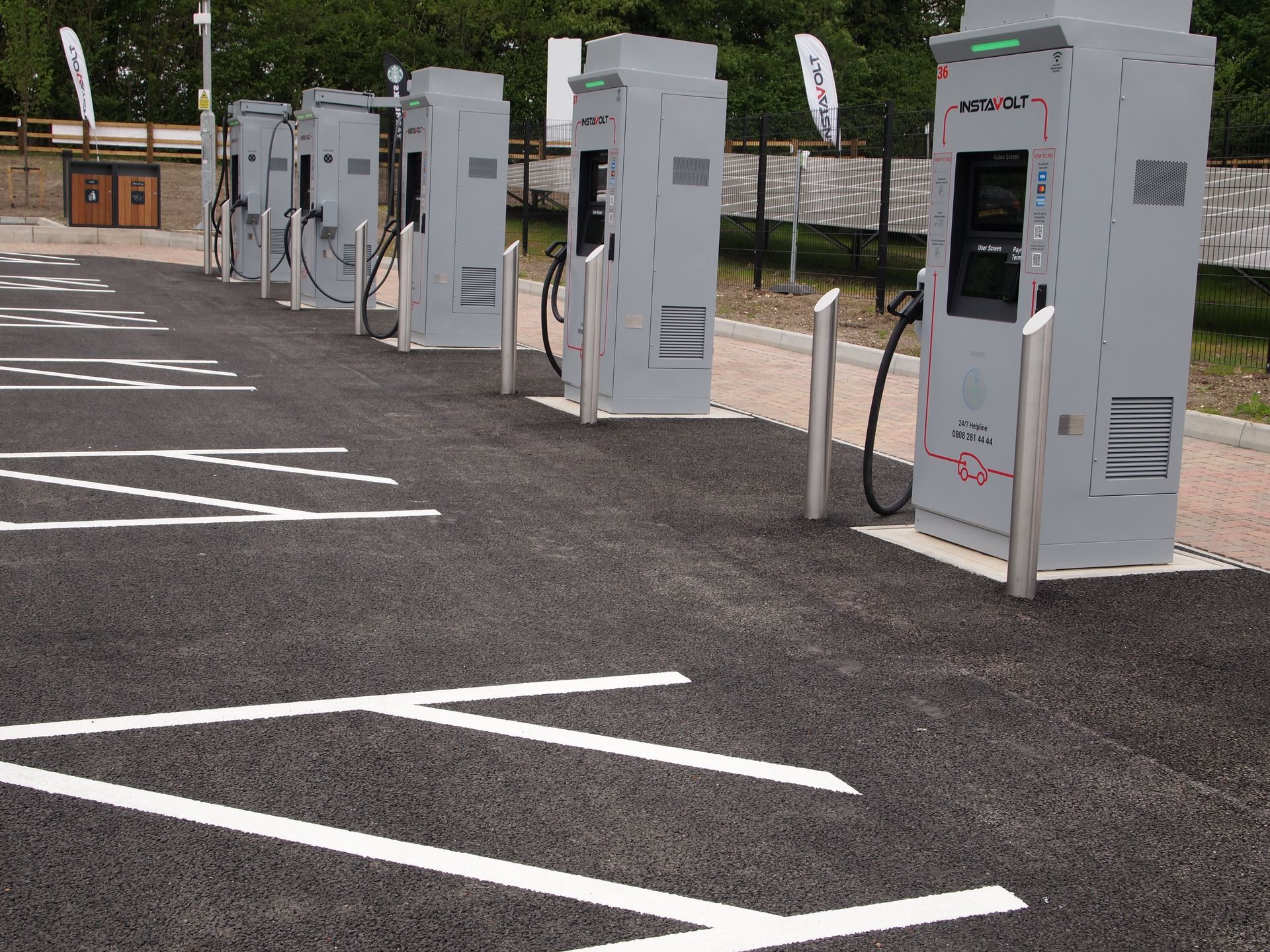

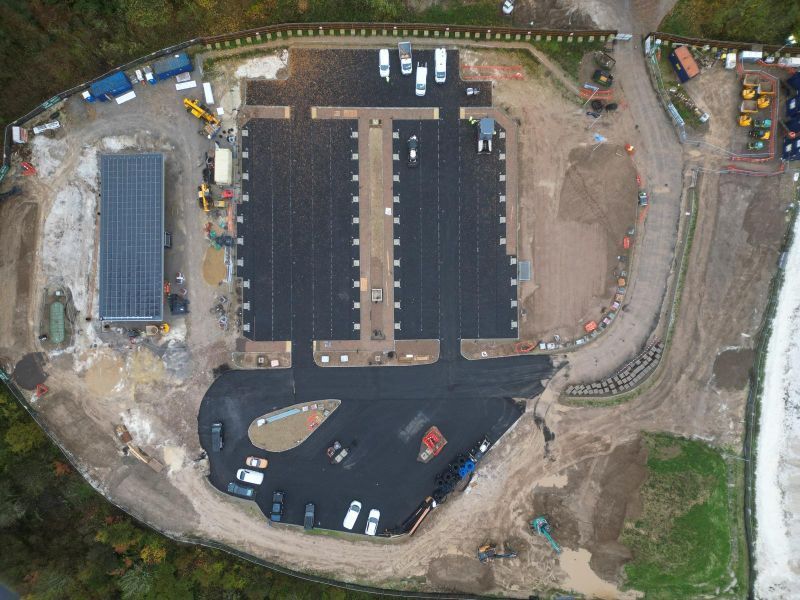

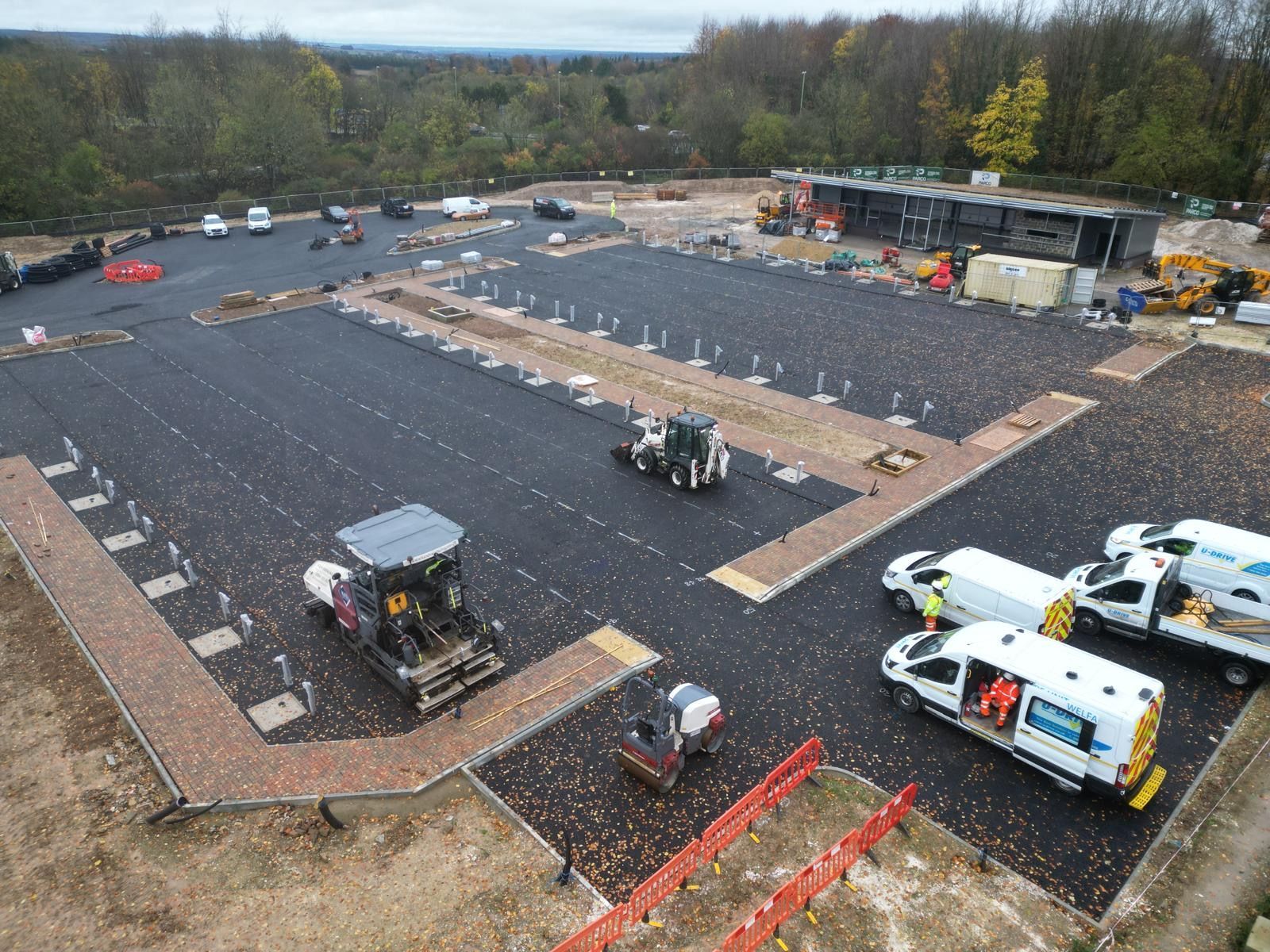

  • All 44 charger pads now in place.

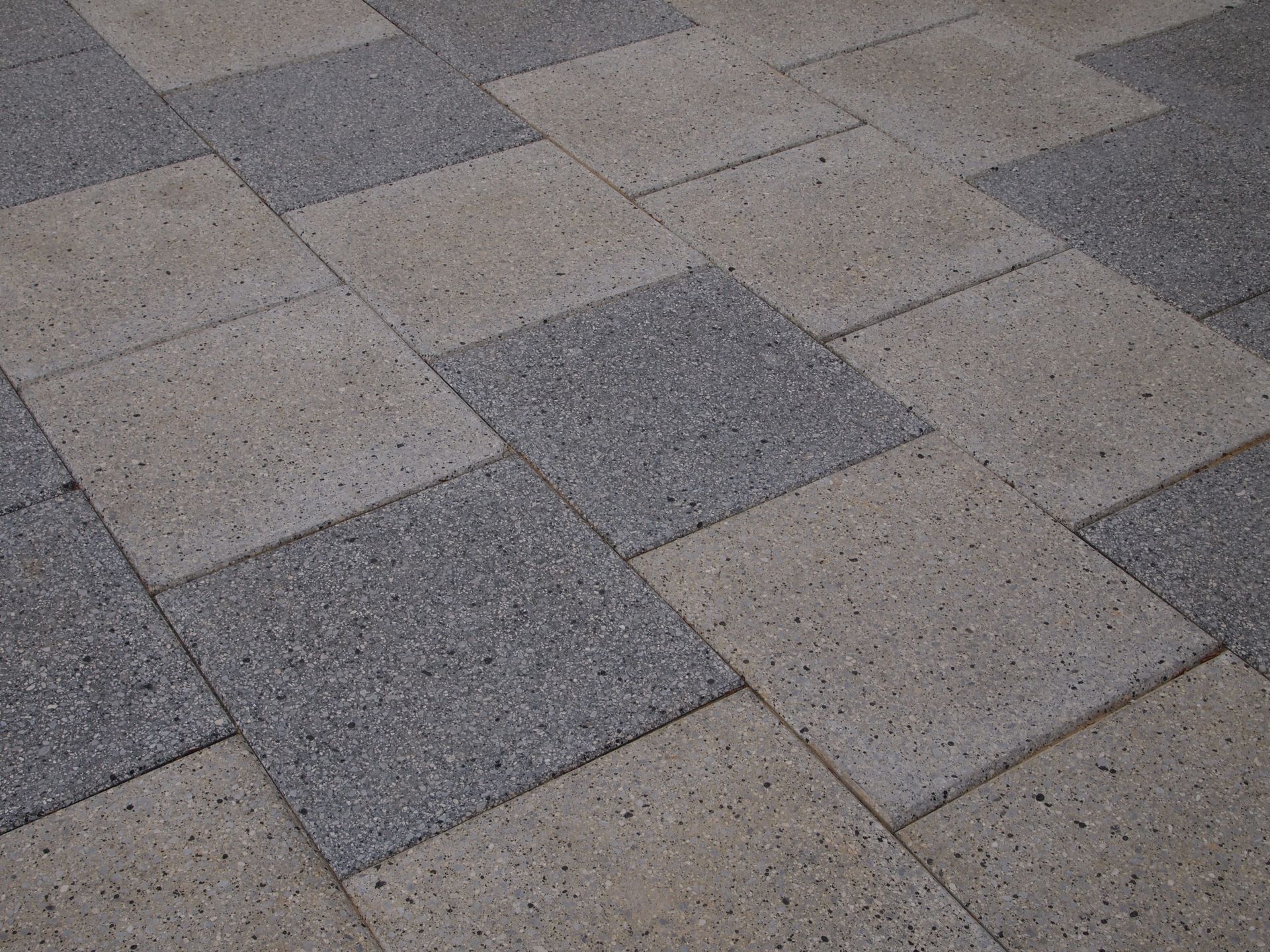

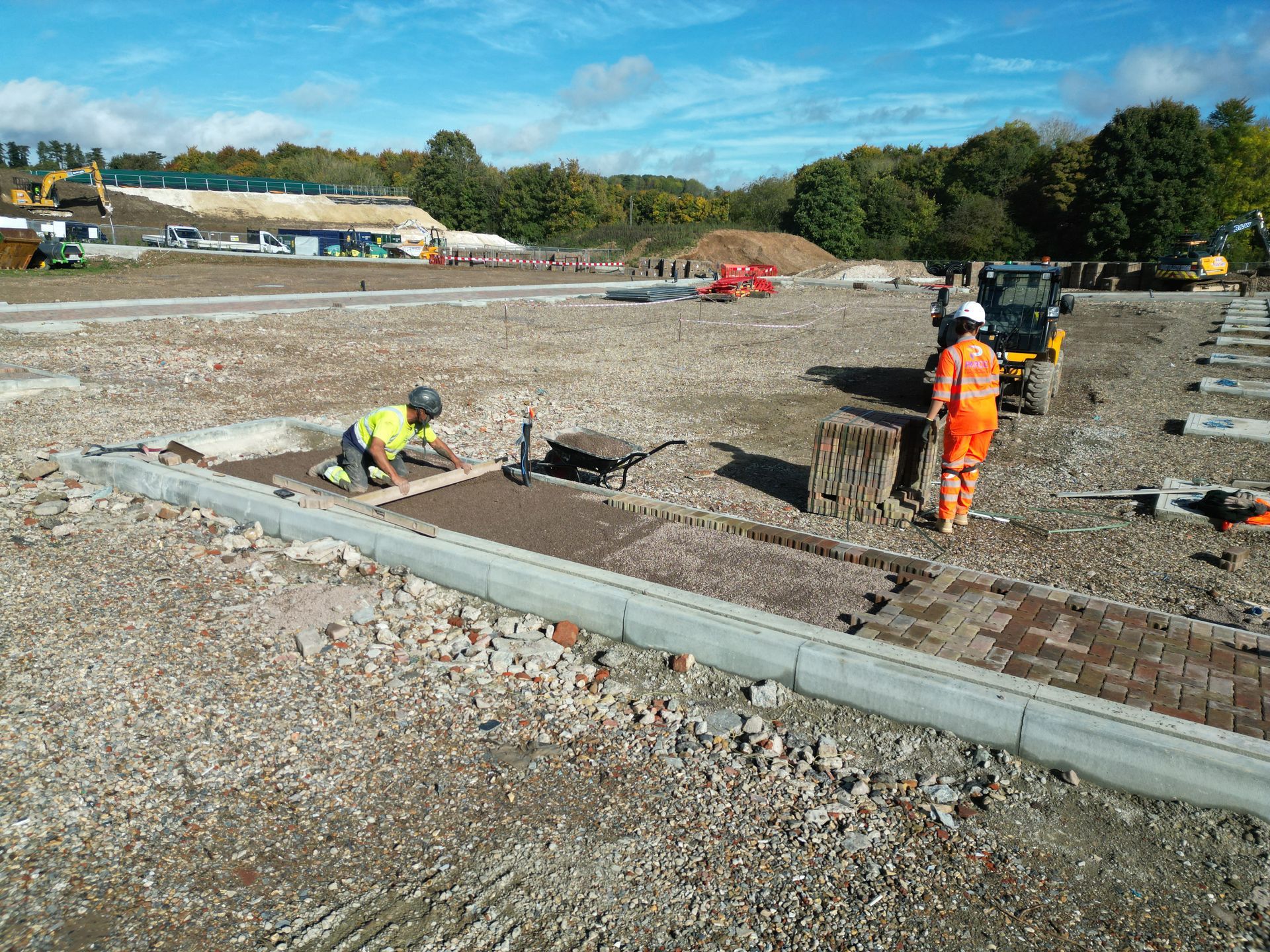

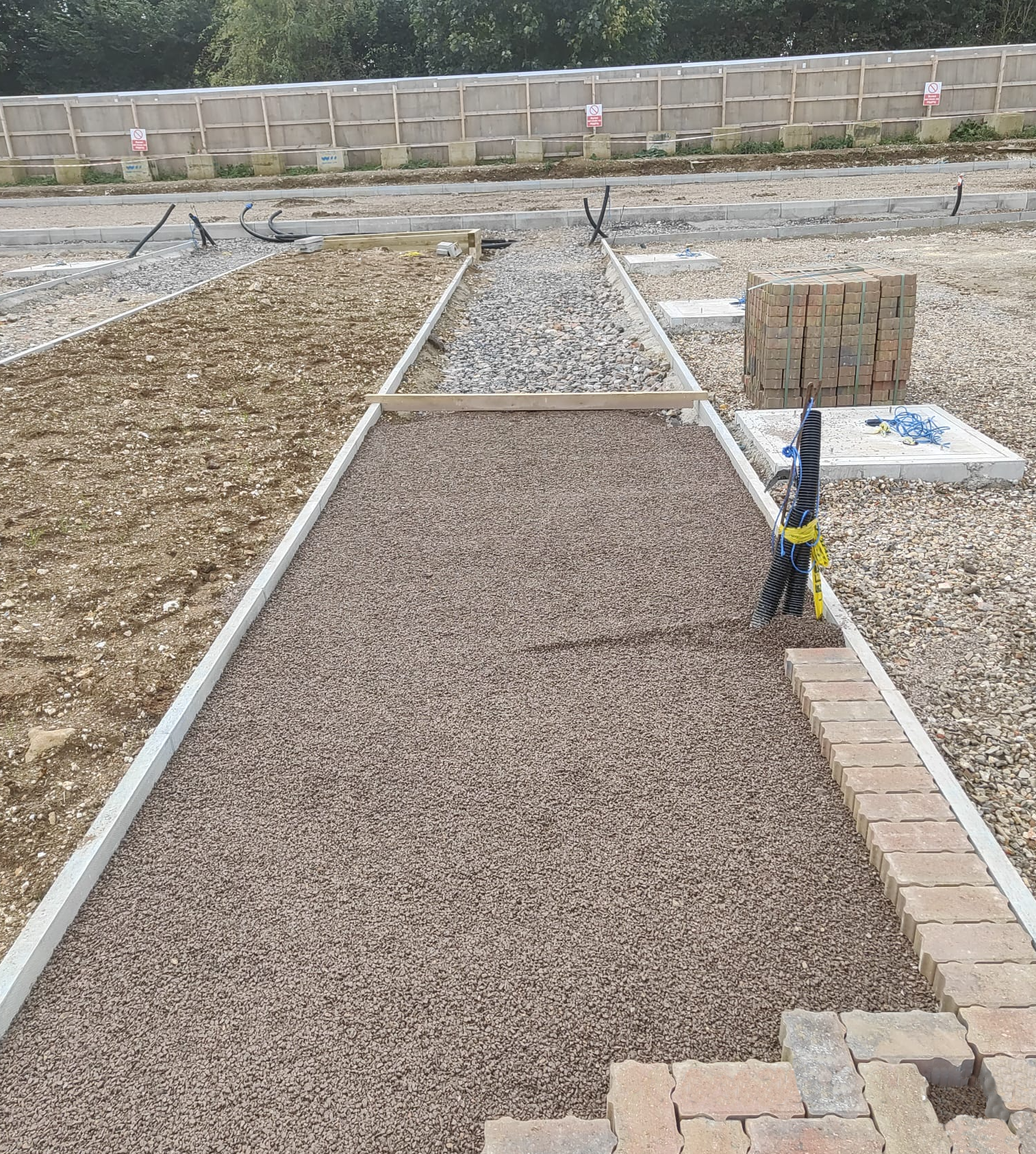

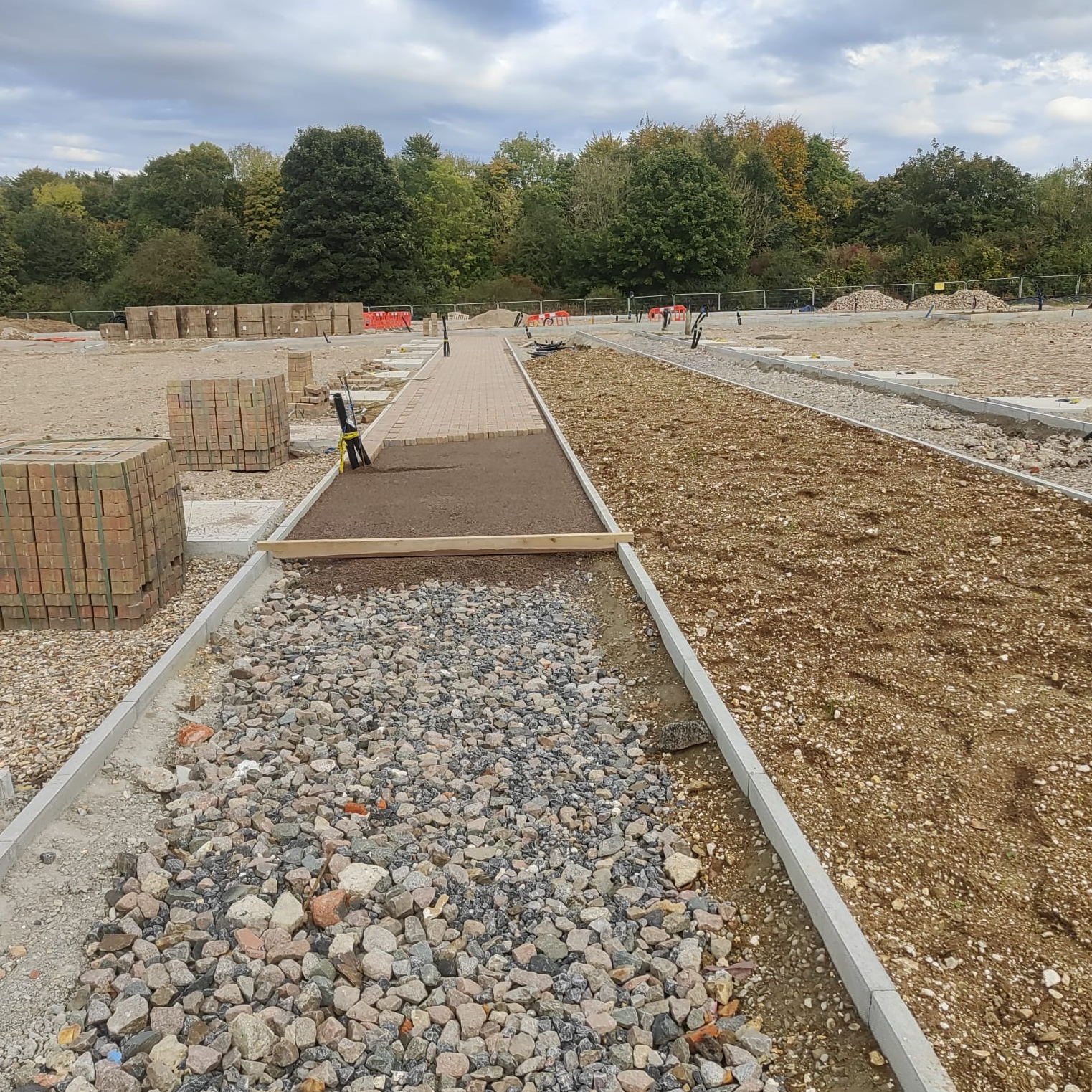

  • 54,000 permeable blocks delivered to site with 26,000 laid within the footways!
quotesArtboard 1 copy 2

"There are now more than 1,100,000 fully electric cars on UK roads and Three Maids Hill is the first of our new generation of Super Hubs. It represents a major landmark for us and will be game changing for EV drivers.

The new site will be truly state of the art and offer a host of on-site amenities including food, drink, and toilets.

Delivering Super Hubs like this is essential to improving the charging infrastructure across the country, bringing continued confidence not only to the sector as a whole but crucially to those motorists who are making the switch to a more sustainable and greener future by choosing to drive an EV."

Delvin Lane

CEO

InstaVolt

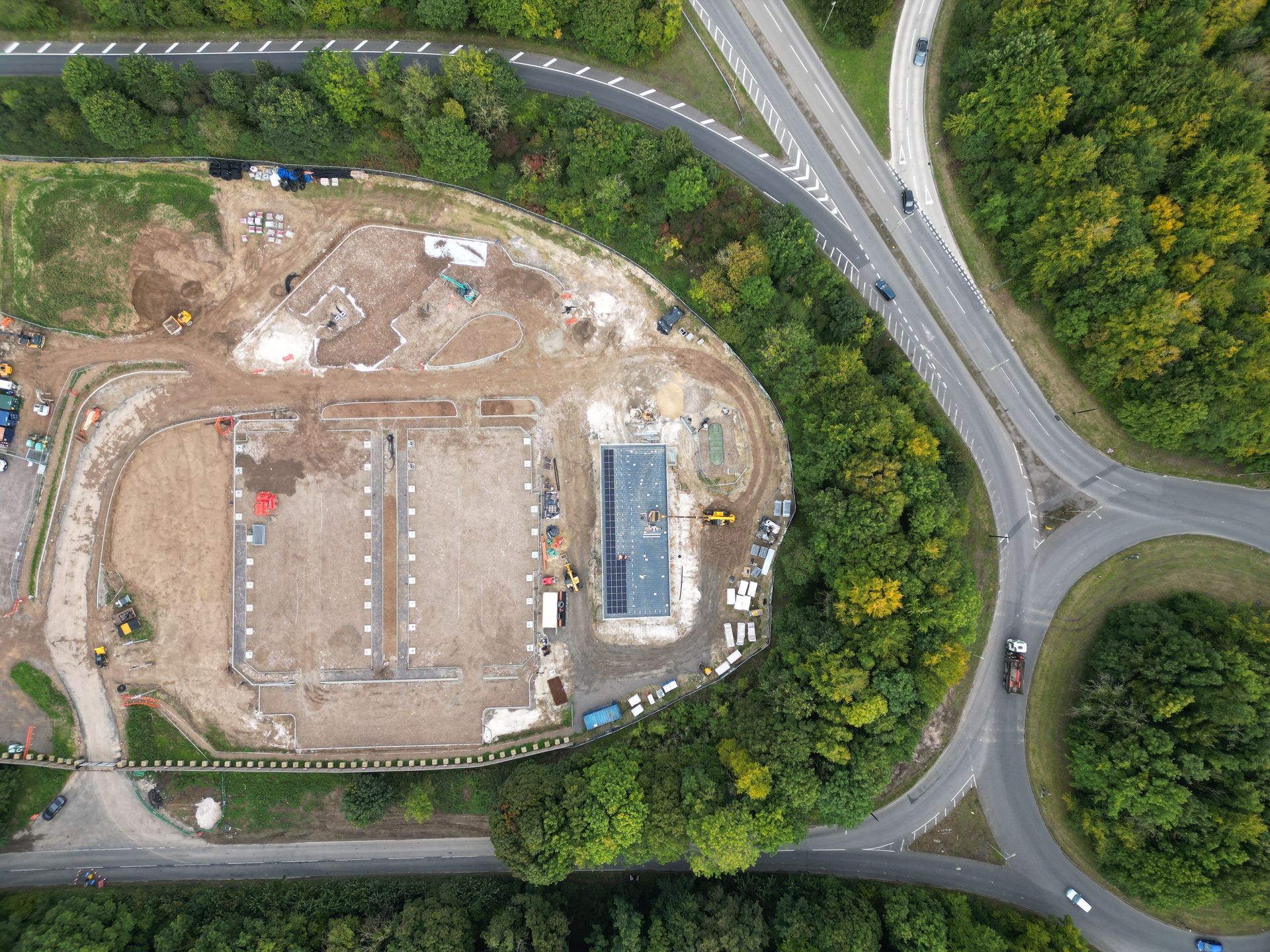

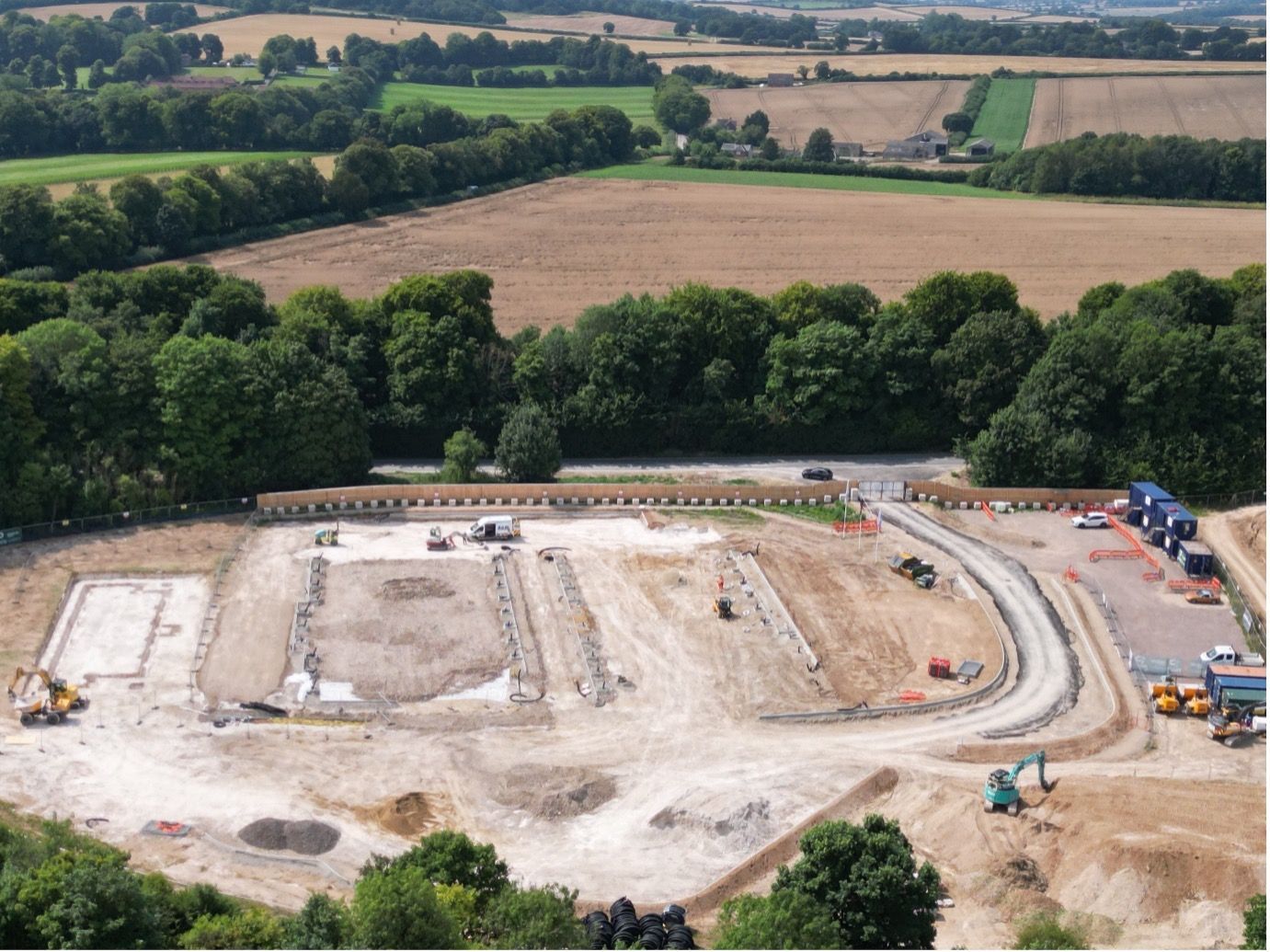

Site development update - September 2024:

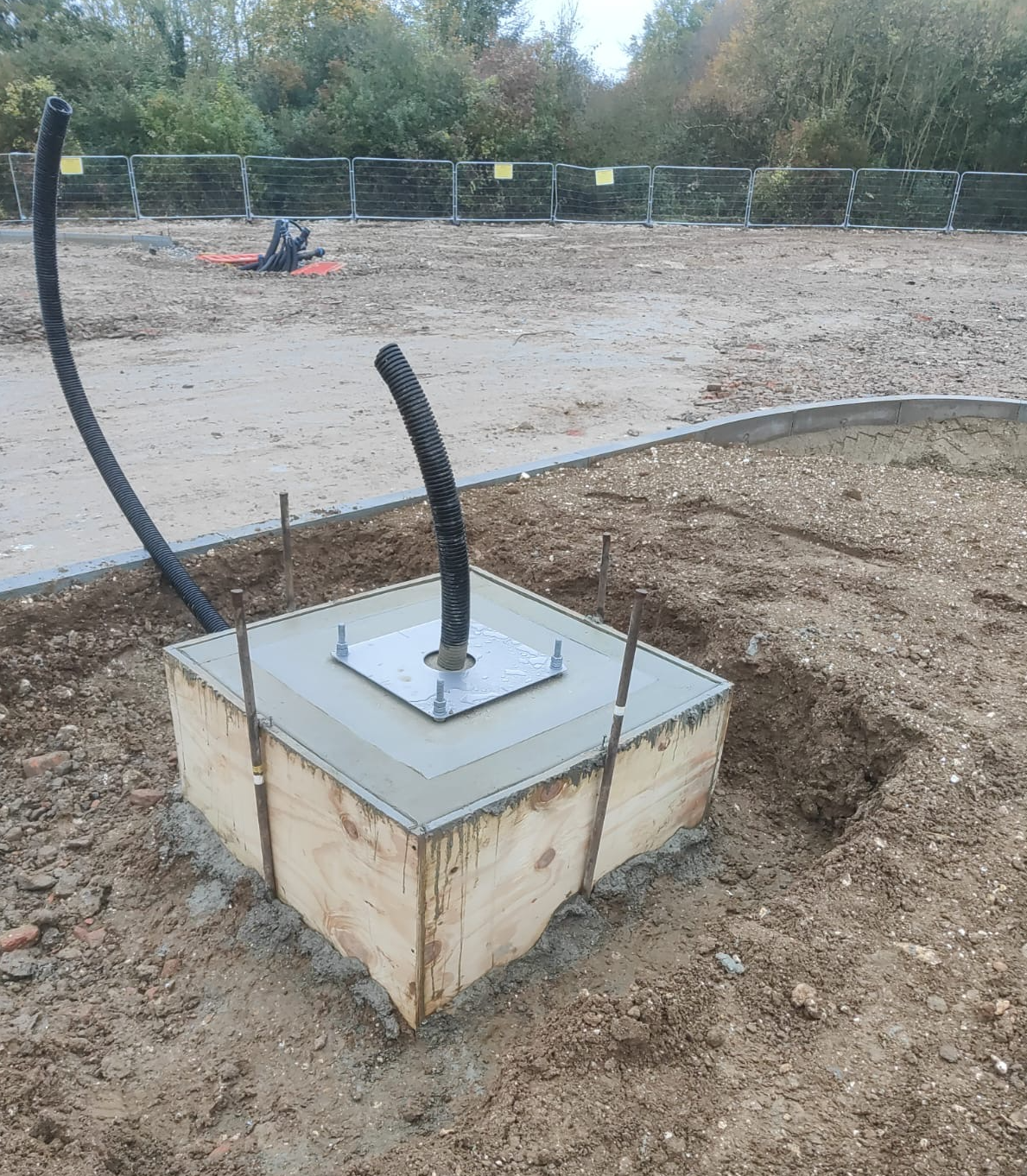

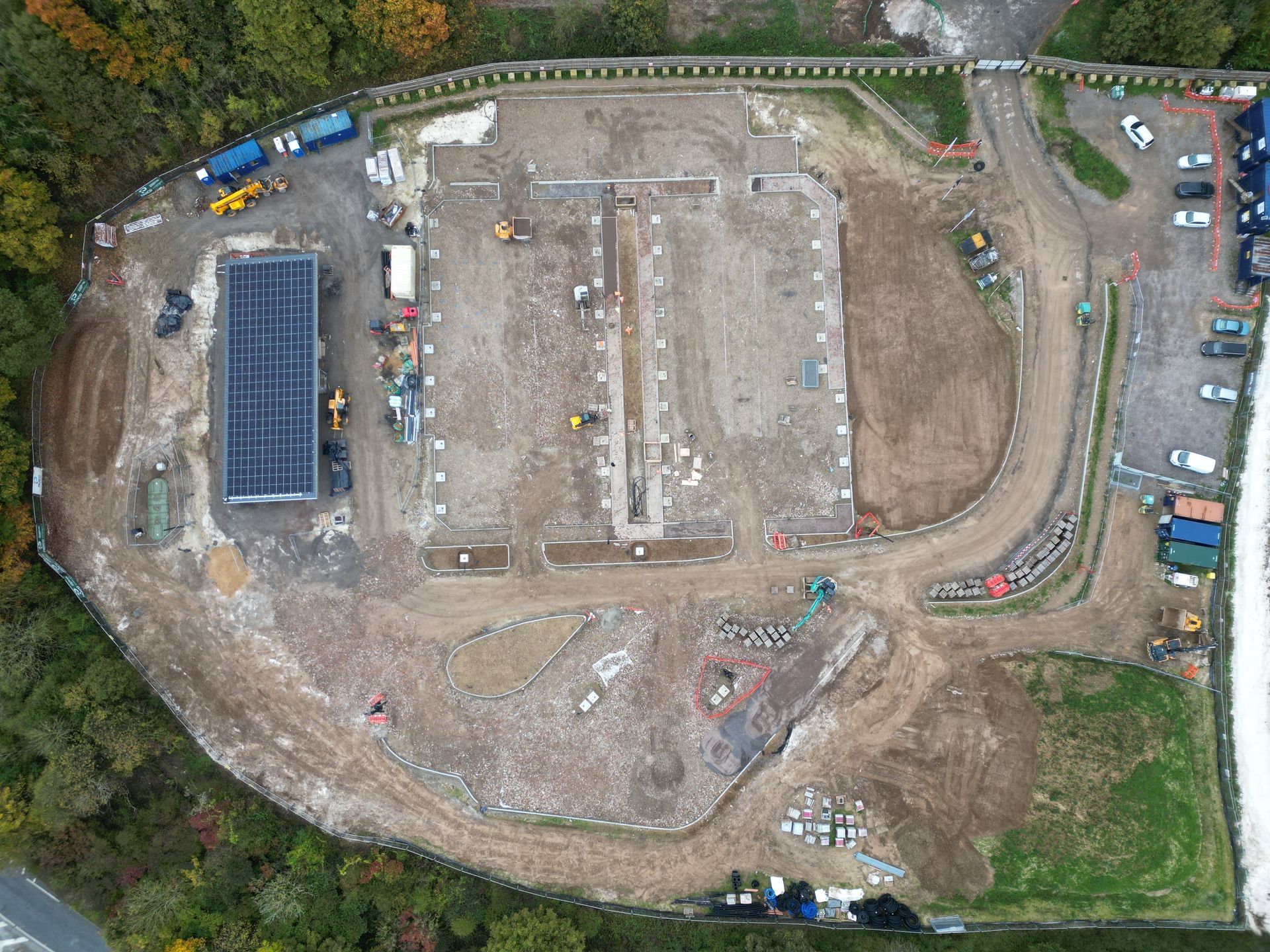

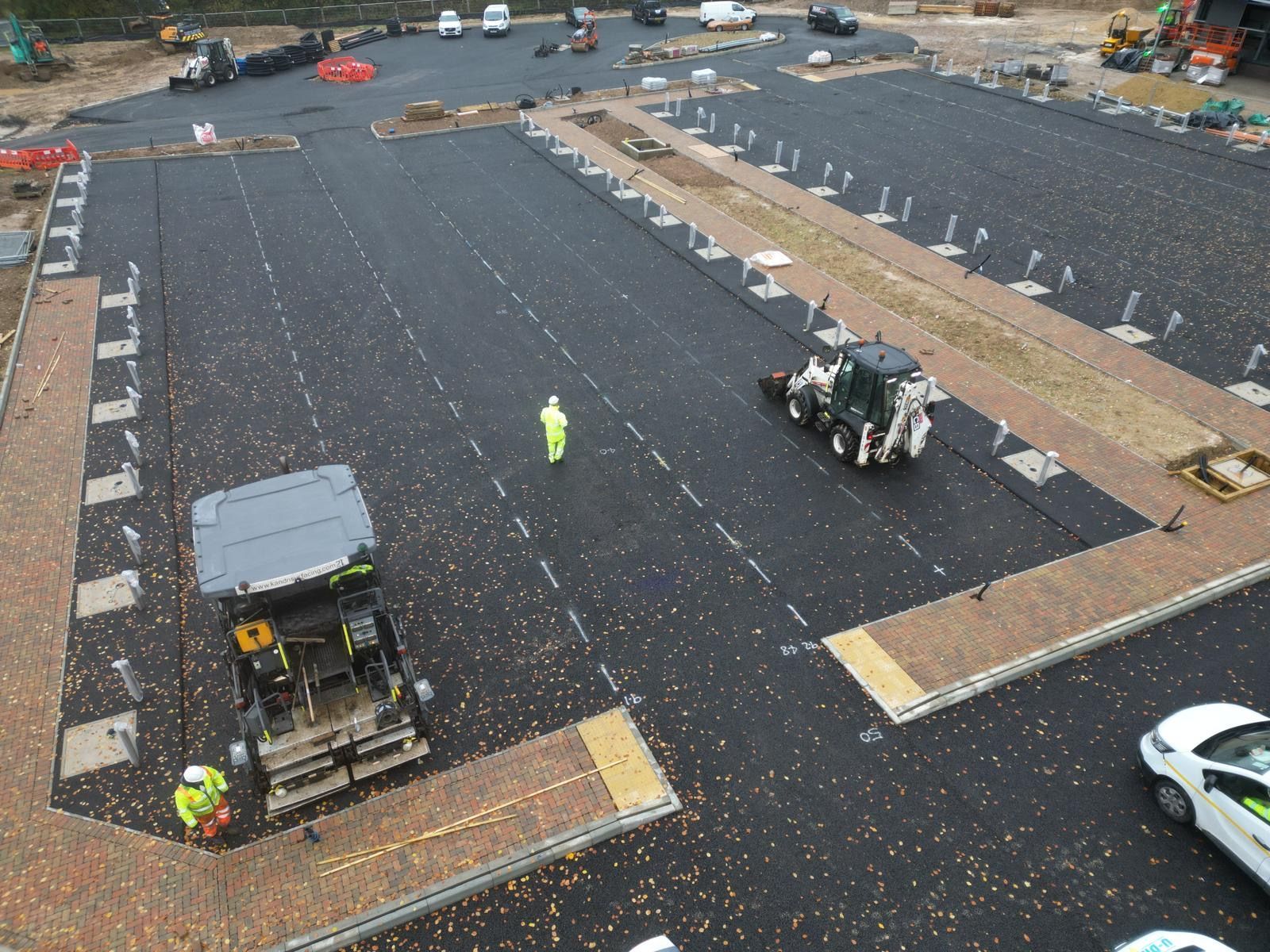

  • 40 charger pads completed (4 more to go).

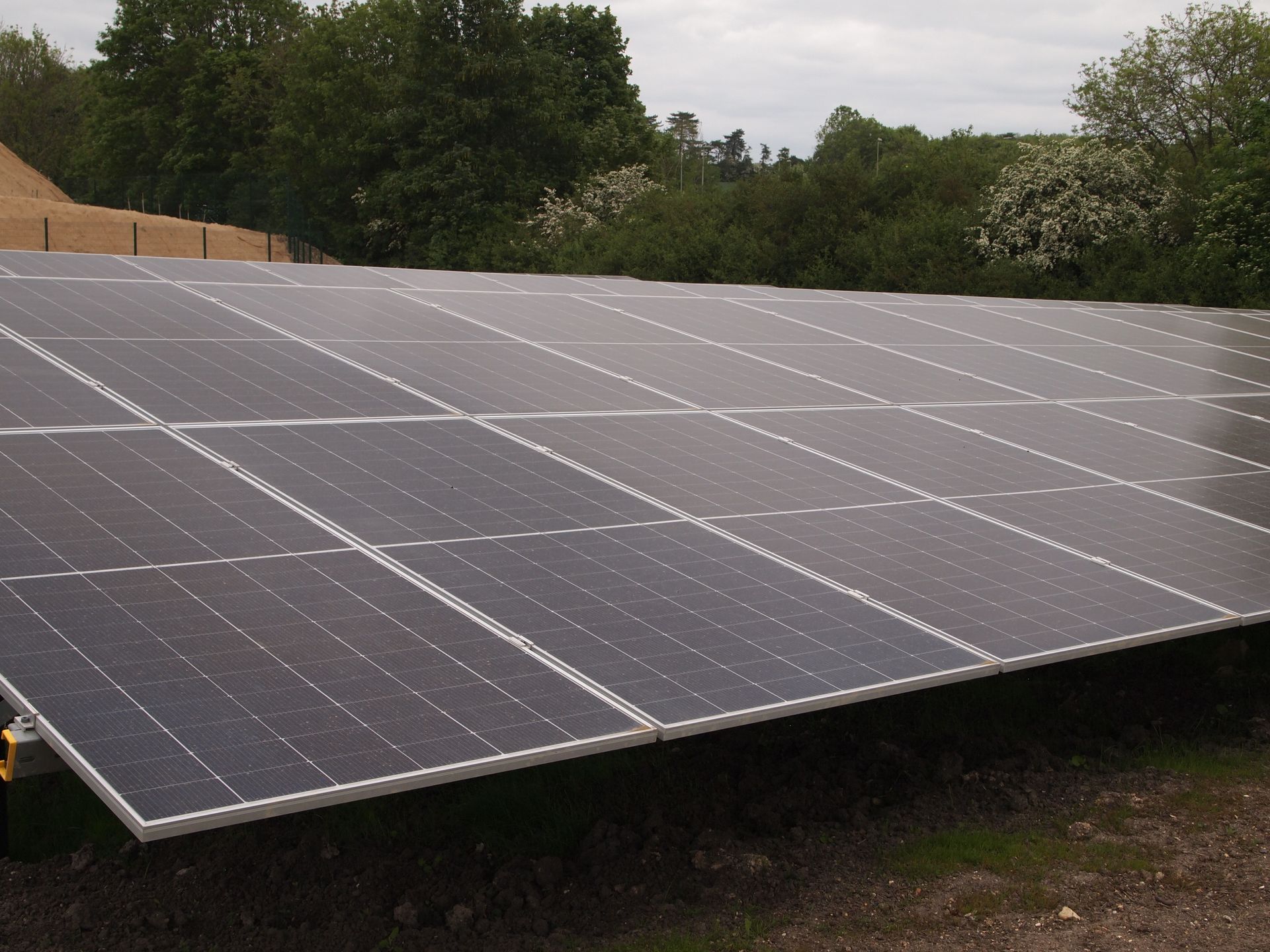

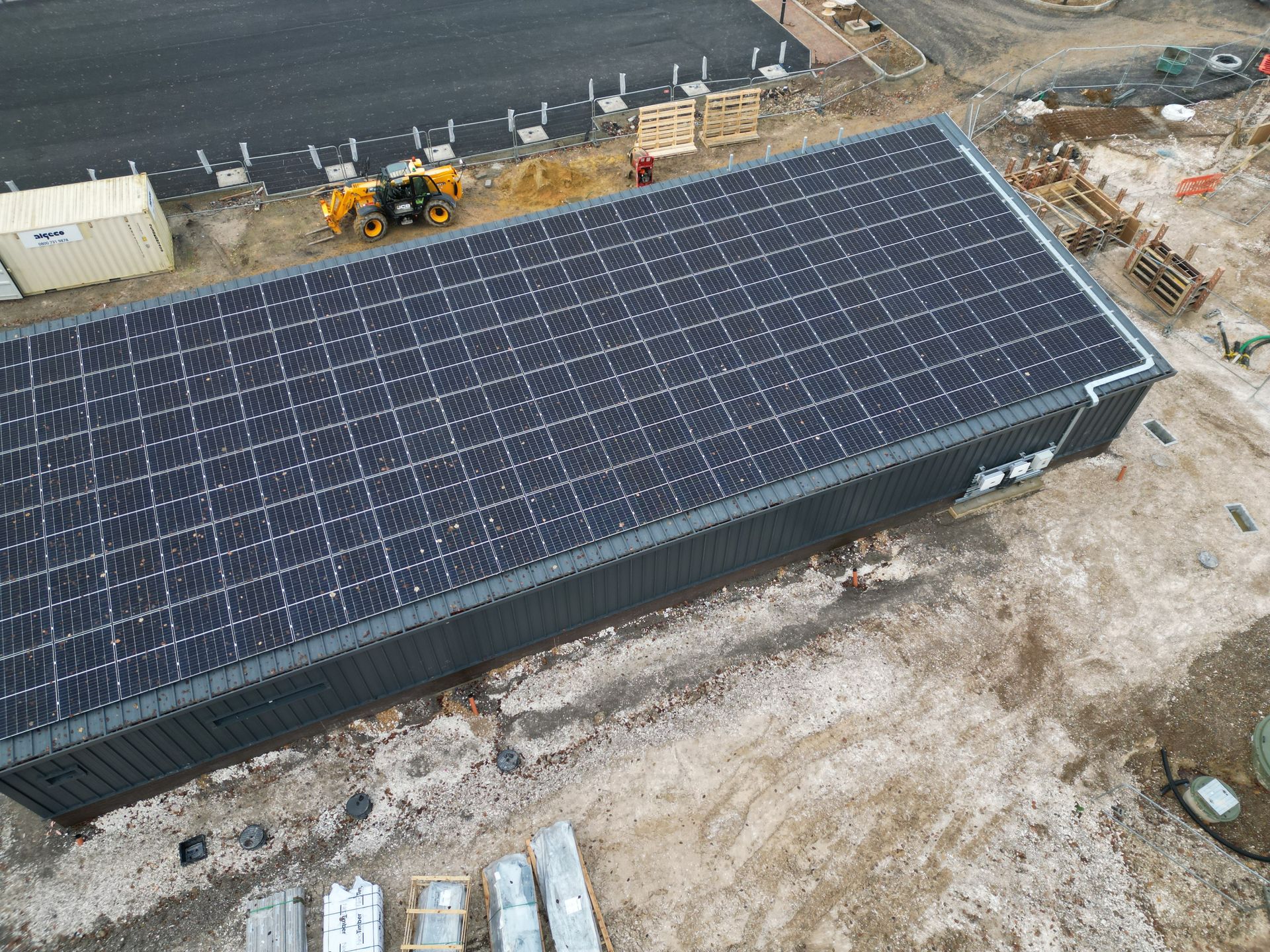

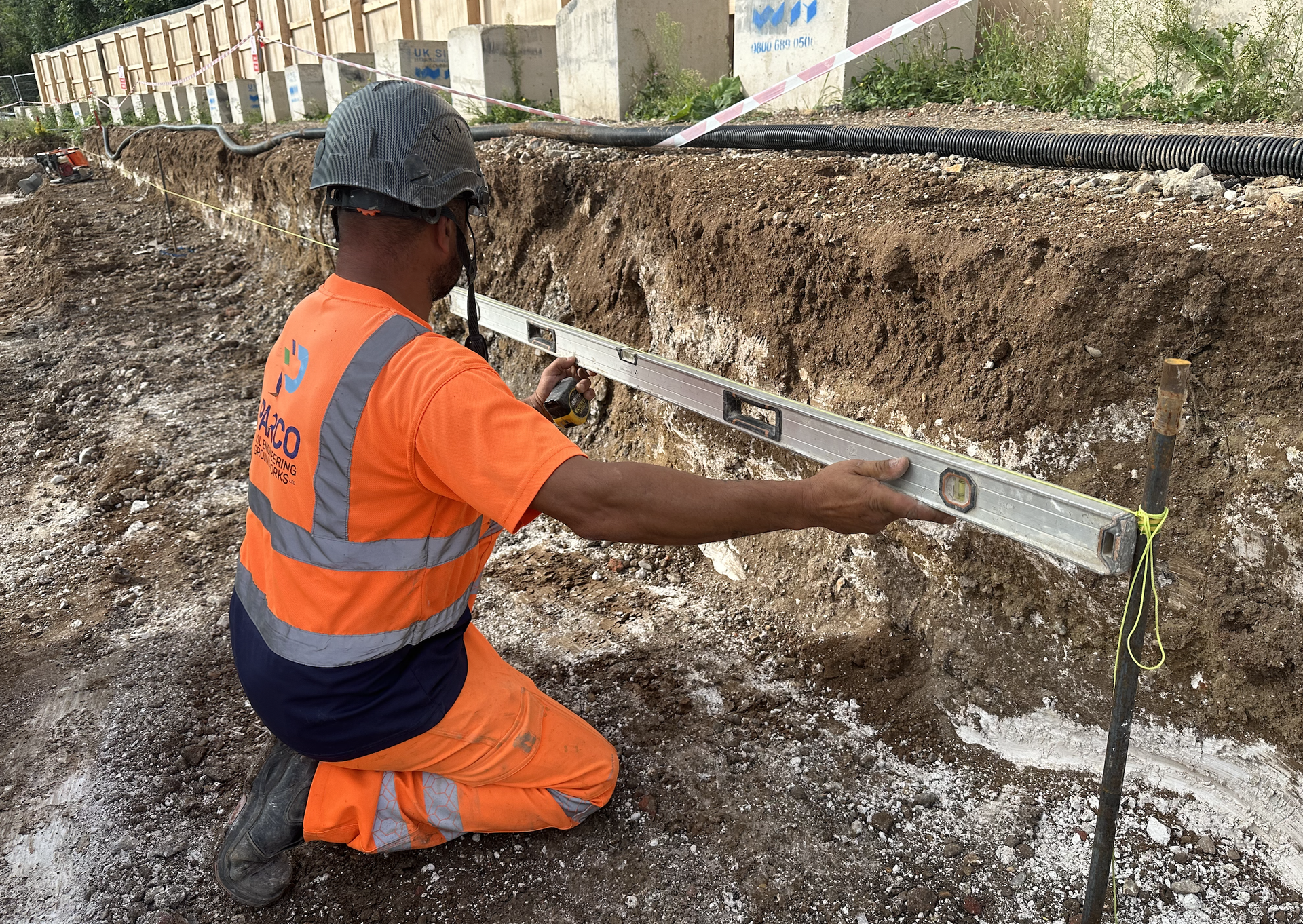

  • Levels raised in the solar farm area – Laying the groundwork for efficient solar power generation.
  • 3.6km of ducting installed – Ensuring robust infrastructure for seamless energy and data distribution across the site.

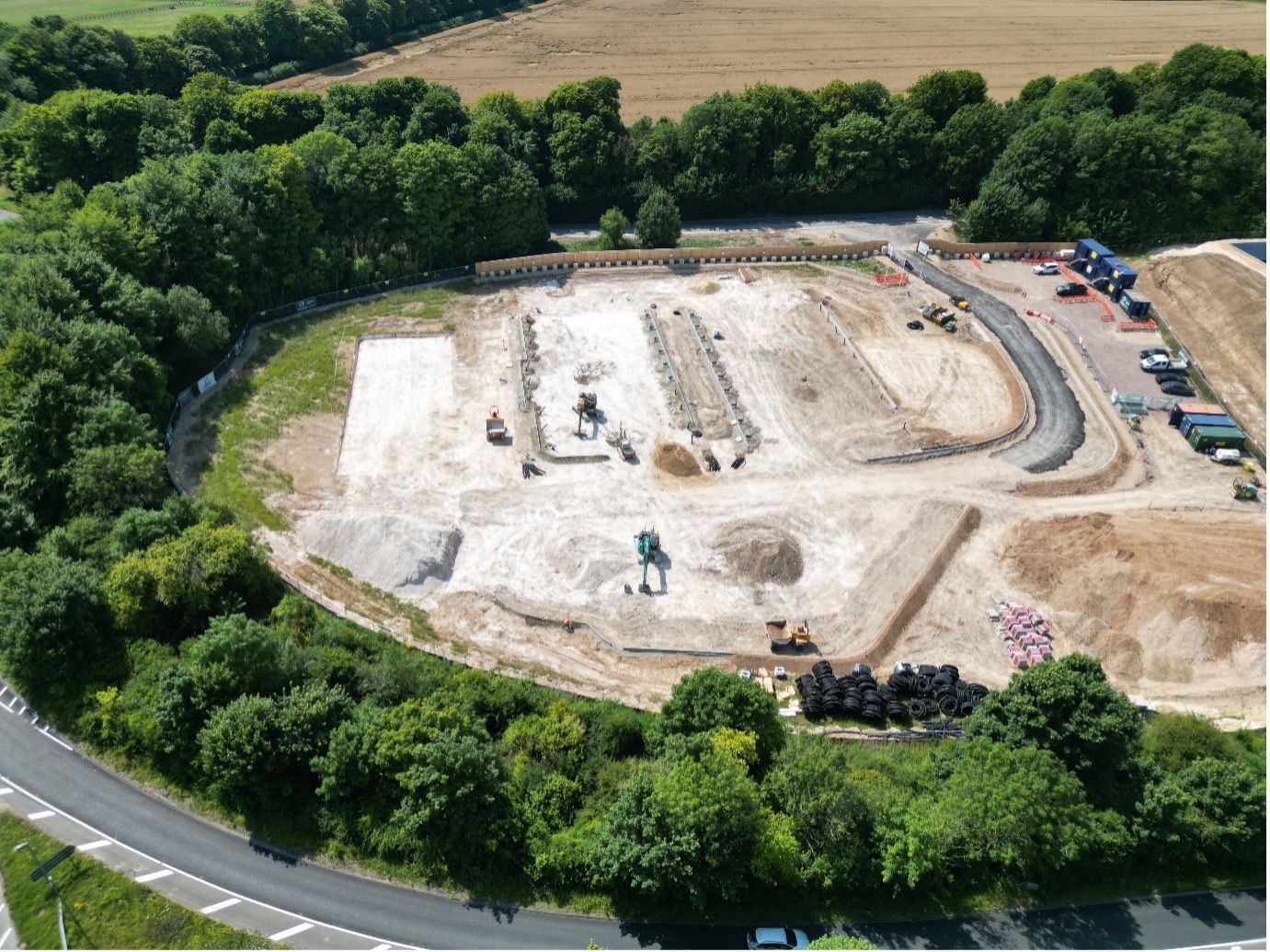

Site development update - August 2024:

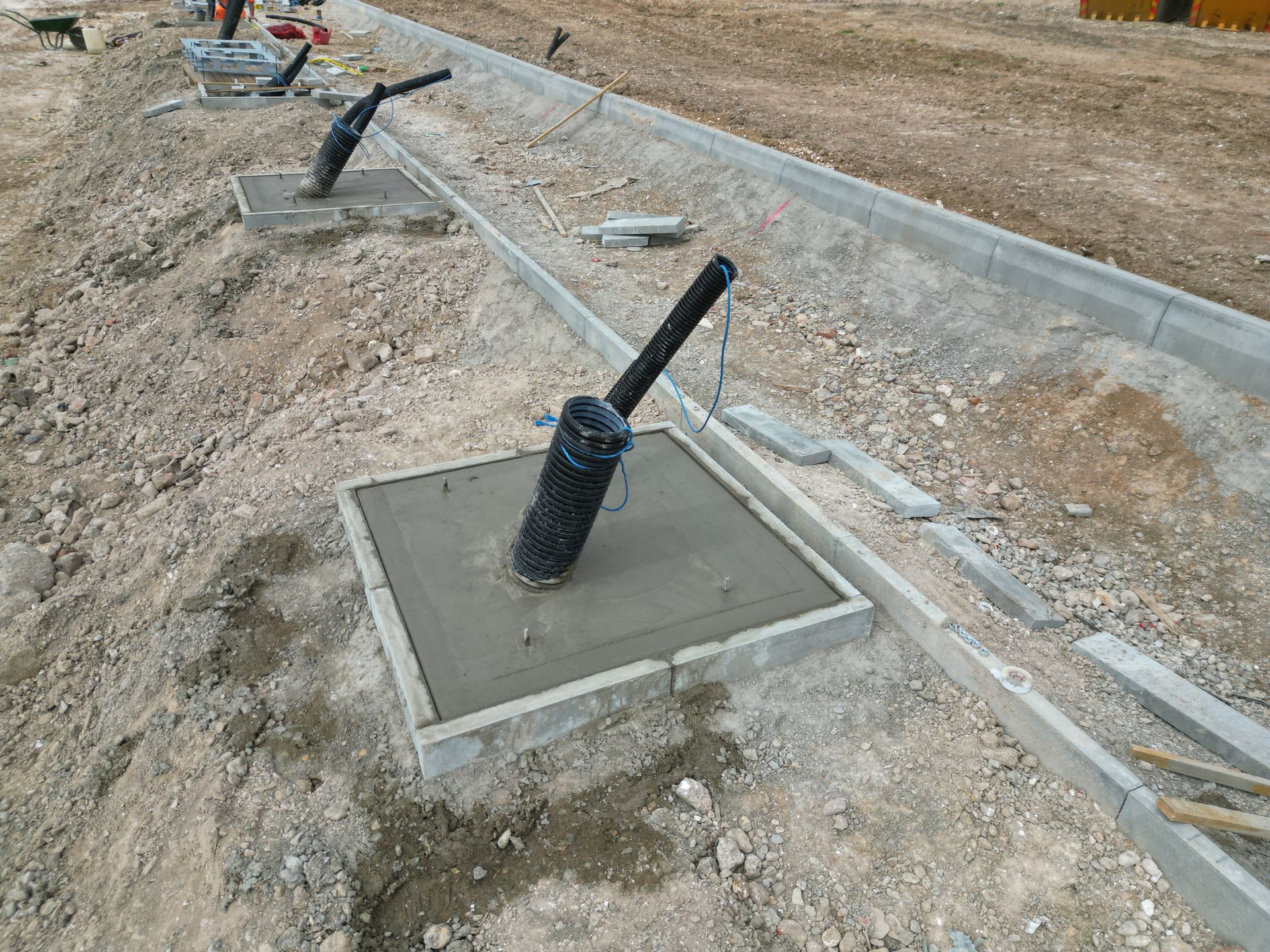

The steel frame for the café is now in place. The Foul Treatment Plant has been successfully installed and 34 (of 44) charger pads and accompanying ducts are now in situ.

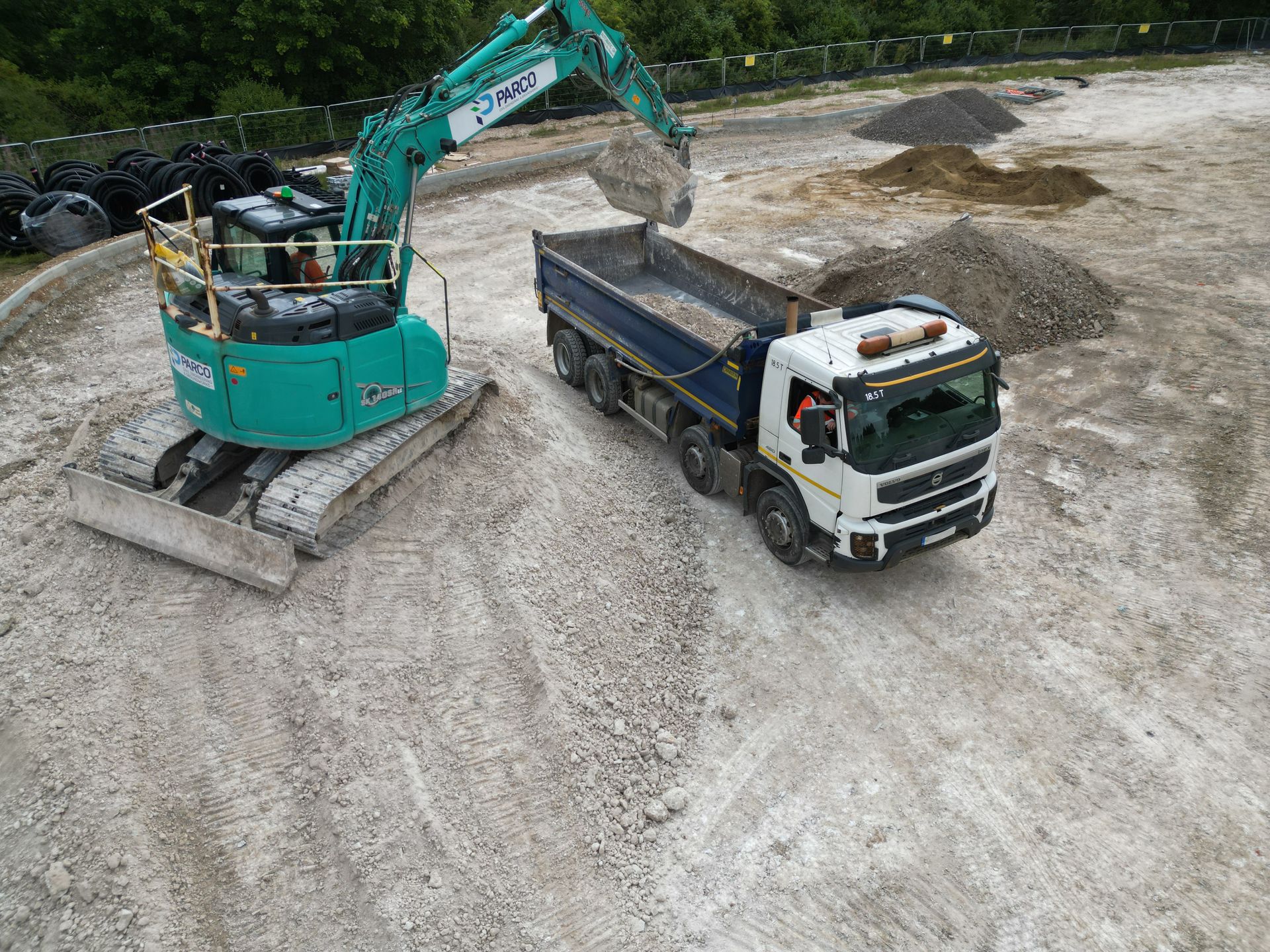

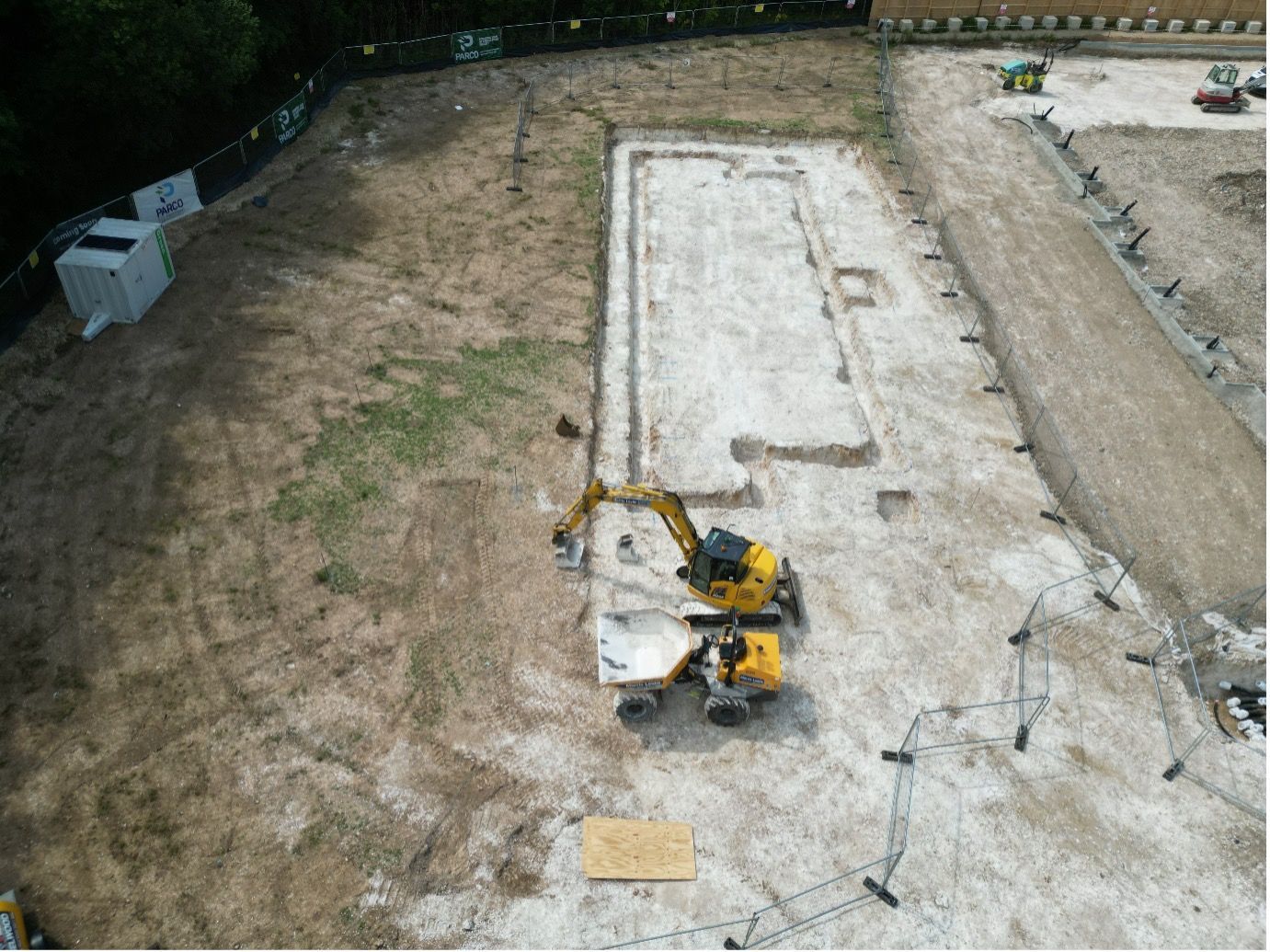

Site development update - July 2024:

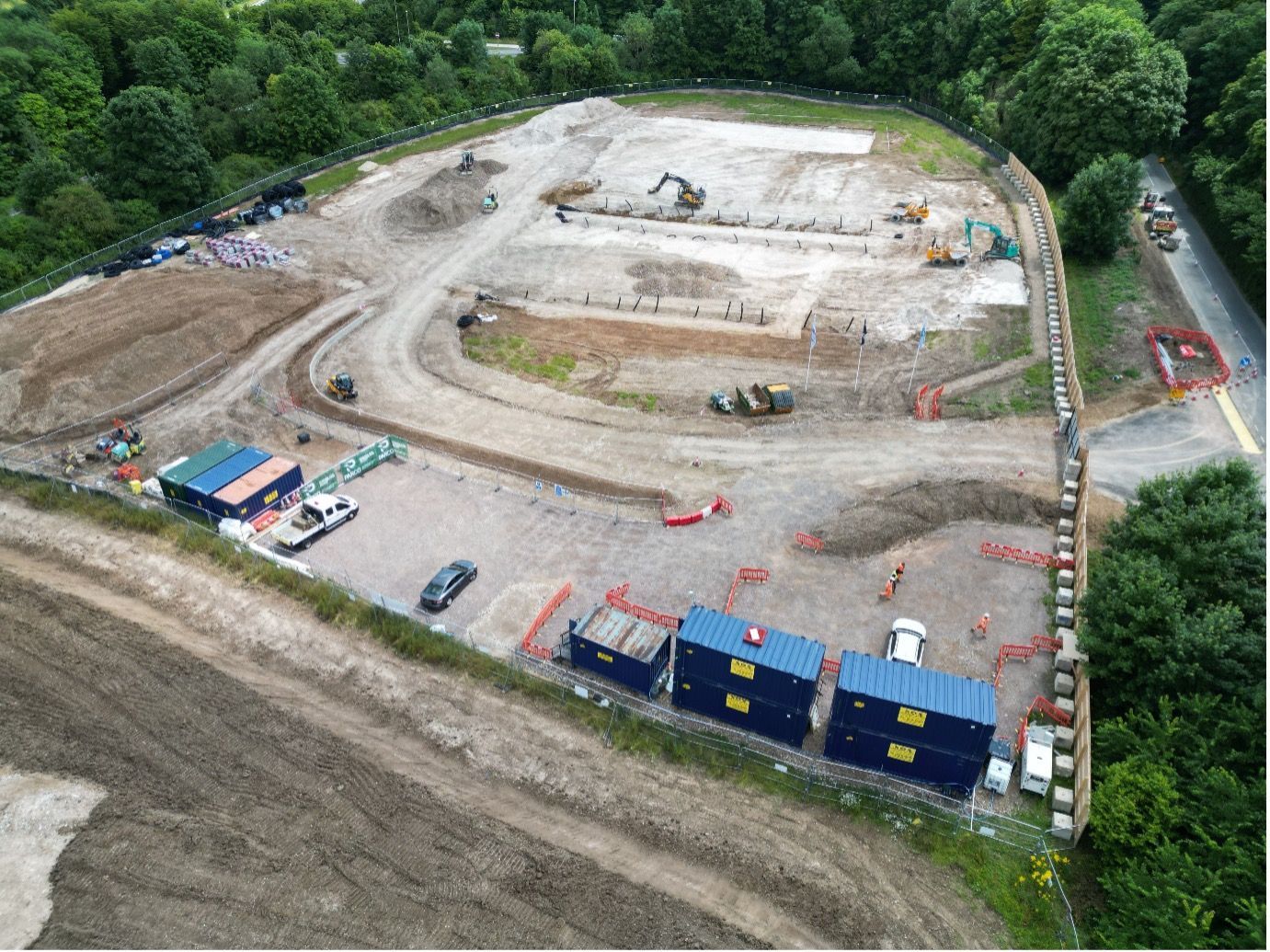

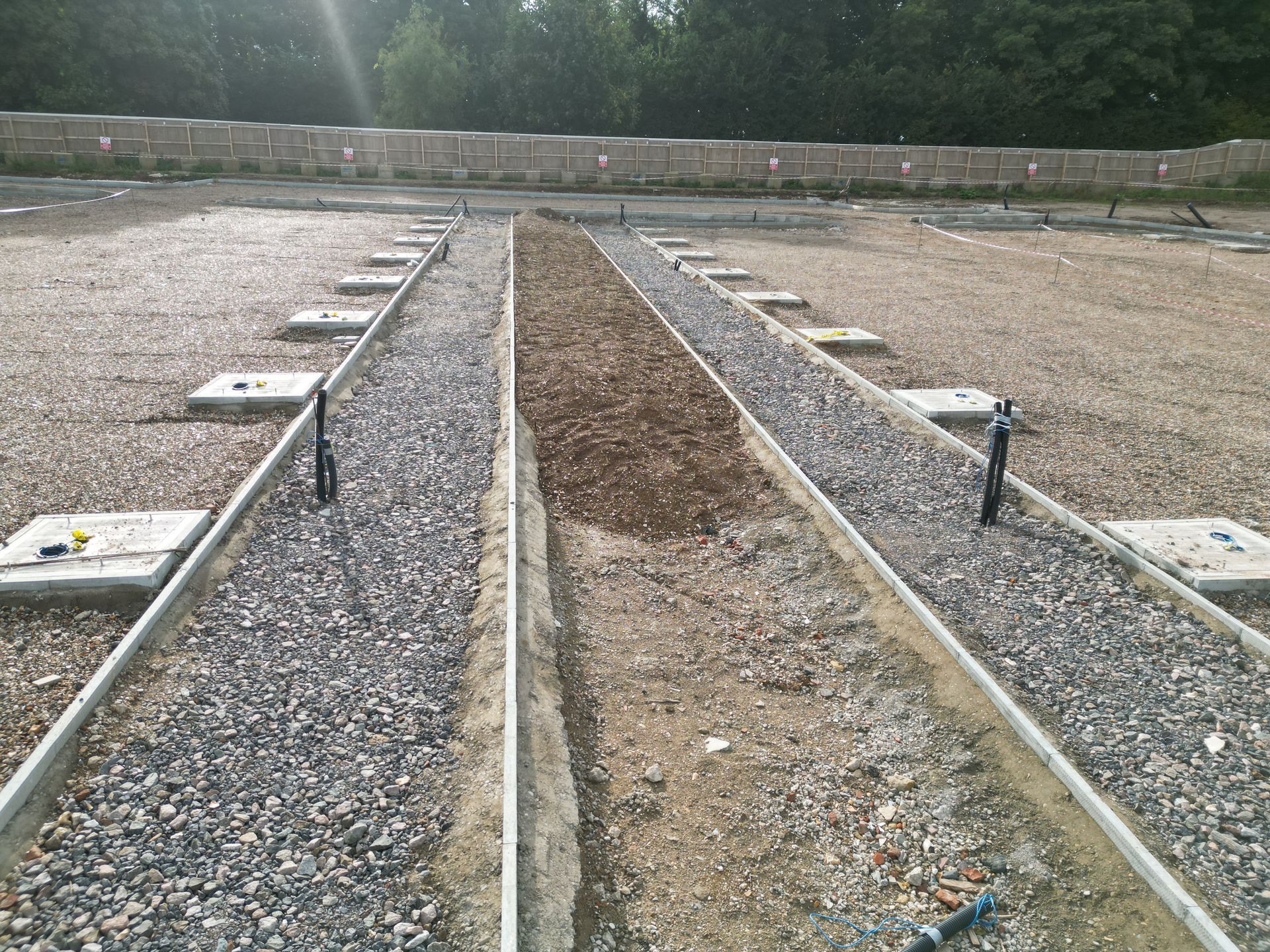

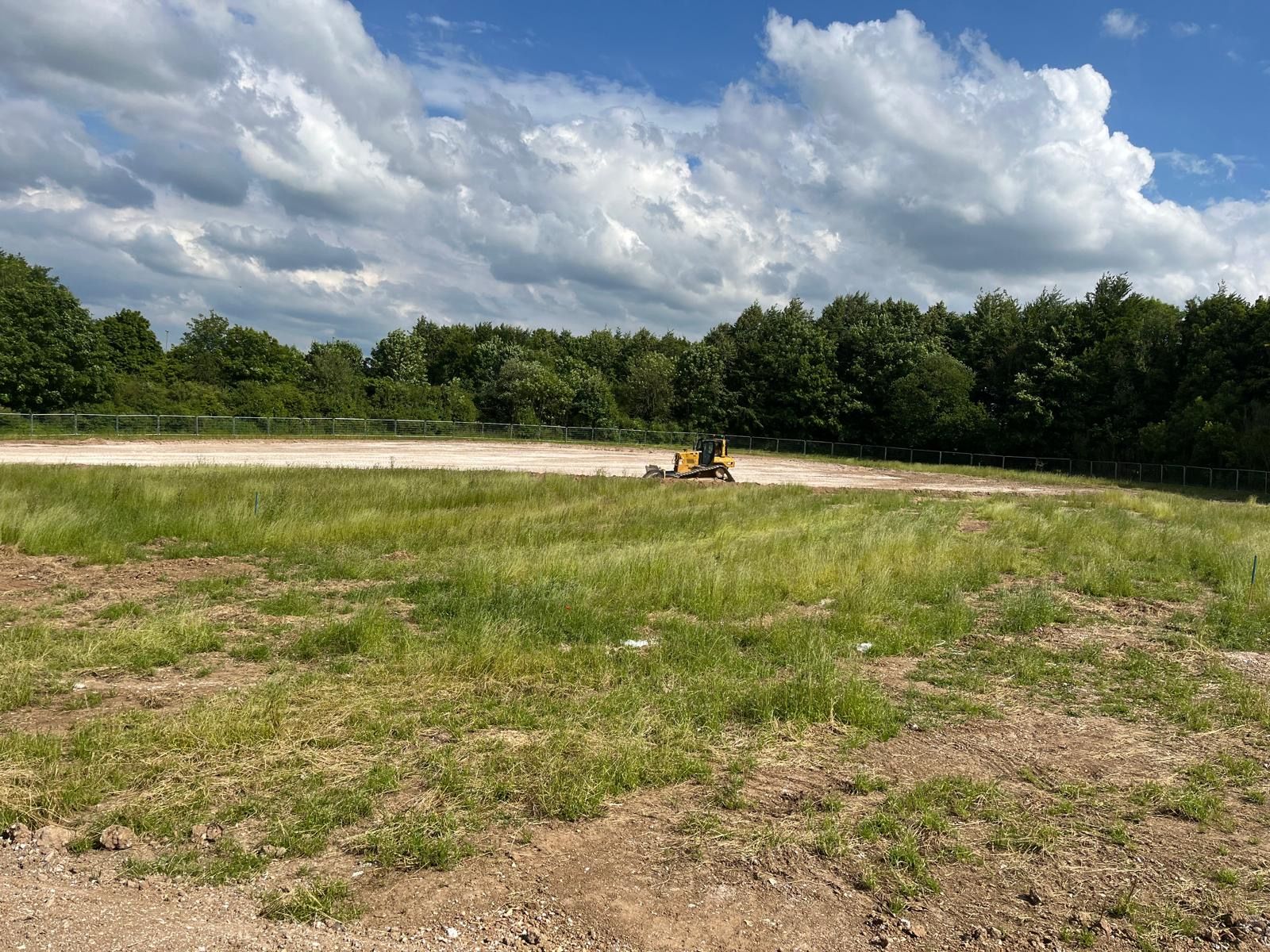

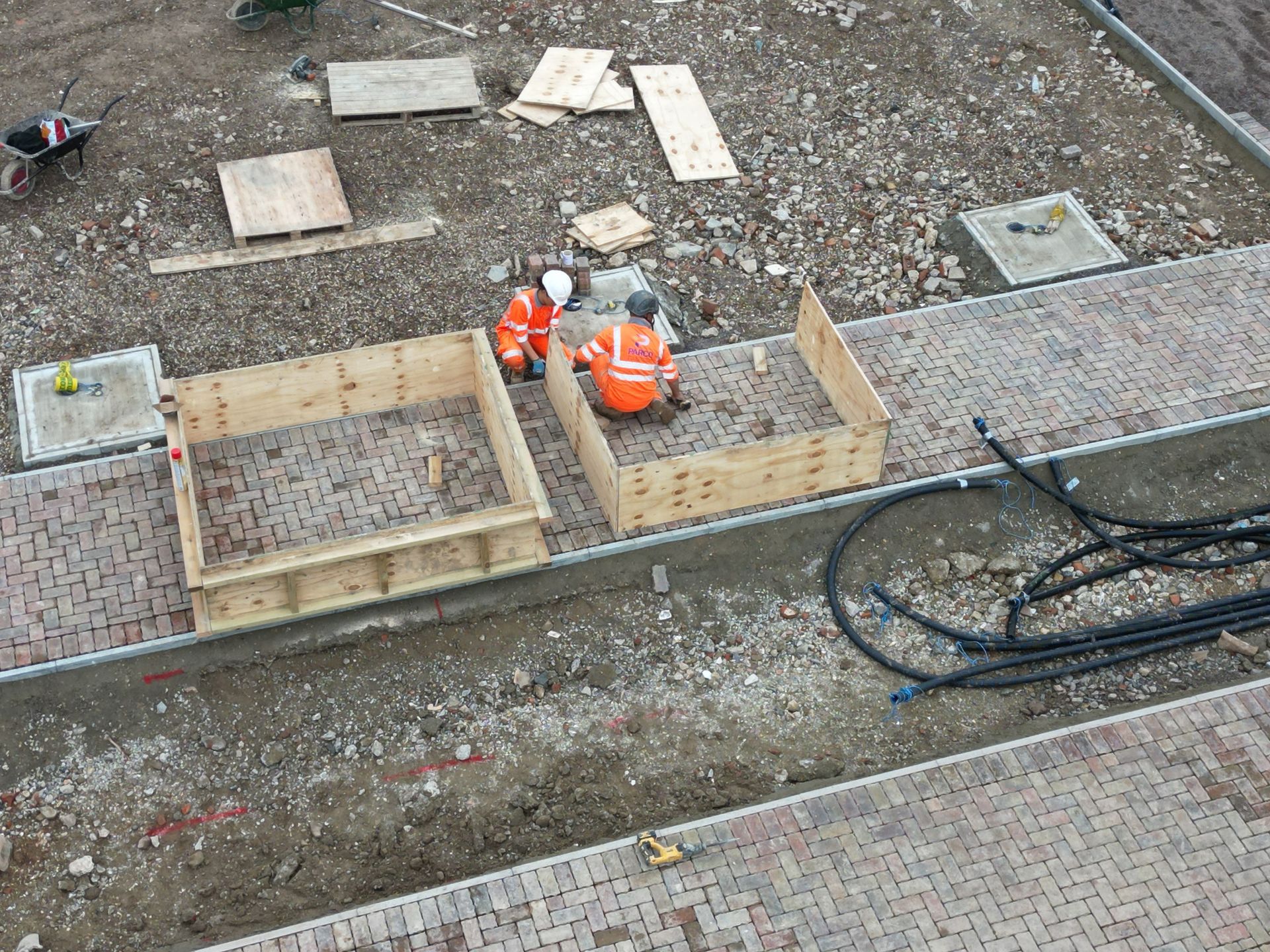

The building footprint has been fully prepared, paving the way for the next steps in the build. Work has begun on the installation of all 44 charger bases, making it clear to see where each charger will be located.
